Package WWTP vs. Custom-Designed Plant: Which One Fits Your Project?
A package WWTP vs custom-designed plant decision in Texas turns on flow, waste strength, effluent limits and phasing, since Chapter 217 applies to both.
Quick answer
A package WWTP is a factory-built plant, usually extended aeration, an SBR or an oxidation ditch, set on a prepared site. MBRs are also sold in package form. A custom-designed plant is engineered around one site's flows, waste stream and effluent limits. In Texas both must meet the same TCEQ design rules in 30 TAC Chapter 217, so the choice turns on flow, waste strength, effluent limits, phasing and who will operate the plant.
What is a package plant?

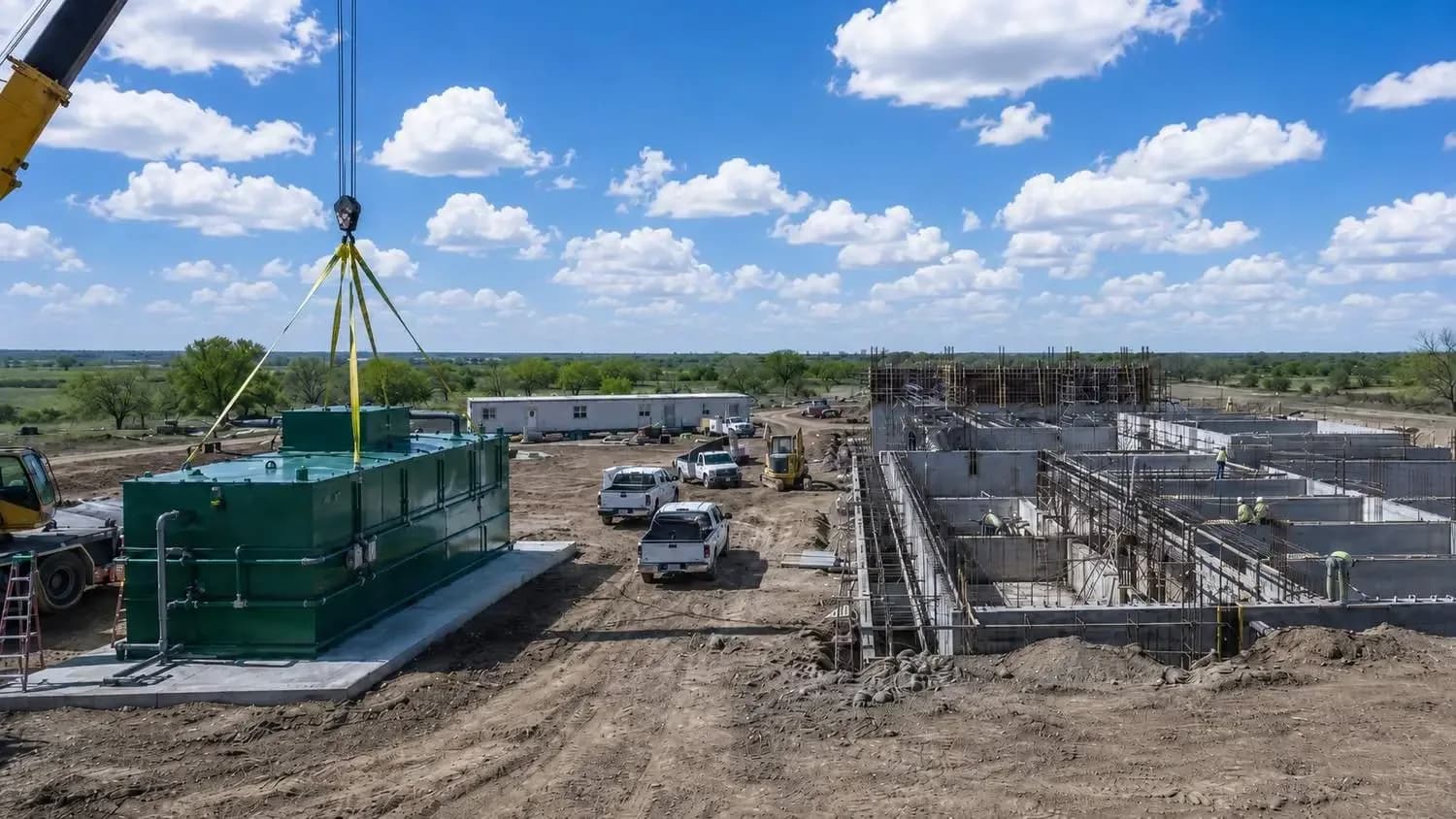

A pre-manufactured treatment plant, shipped whole or in modules and set on a prepared site. EPA's package plant fact sheet, from 2000 and citing manufacturers, puts their common range at 0.01 to 0.25 MGD, or 10,000 to 250,000 gallons per day. Designs run from 0.002 to 0.5 MGD.
Extended aeration is the workhorse: a long aeration time, simple operation and steady secondary effluent. The same fact sheet says package extended aeration units are typically built for up to 0.1 MGD, and concrete tanks may suit larger sizes better.
An SBR treats in batches, filling, aerating, settling and decanting in the same tank. It can be set up to remove nitrogen and phosphorus, but EPA notes its performance depends heavily on the operator.
An MBR replaces the clarifier with membranes, fits in a small footprint and produces effluent suited to reuse. EPA's 2007 membrane bioreactor fact sheet says its main drawback is higher capital and operating cost, from membrane cleaning, fouling control, replacement and air scouring.
What is a custom-designed plant?
A plant whose processes are chosen and sized for one project, not taken from a catalog. The engineer picks the aeration, clarification, solids handling and disinfection from the project's flows, loadings and permit limits.
It takes more engineering effort up front. In return, it fits the project's actual operating range and can carry an expansion path, such as room and piping for a second train, from day one.
Industrial or high-strength waste, tight nutrient limits, a reuse quality target or a flow beyond the package range usually push a project toward custom design. Our wastewater engineering work in Texas covers both paths.

Does TCEQ treat a package plant differently?
No. Chapter 217 has no lighter path for a factory-built plant. It applies to domestic wastewater treatment facilities without a separate track for package units.
Under TCEQ's submittal rule, 30 TAC §217.6, the plans must be based on a design that meets at least the permit's effluent limits. The engineer's sealed summary transmittal letter certifies that the design substantially complies with Chapter 217, and TCEQ may call it in for full review with an engineering report.
Check the catalog unit against the rule, not the brochure. Two examples:
- Under TCEQ's SBR rule, 30 TAC §217.156, an SBR needs multiple tanks, a side water depth of at least 12 feet and enough decant volume to pass the design flow with the largest basin out of service. A single-tank package SBR does not fit that as written.
- Under TCEQ's MBR rule, 30 TAC §217.157, an MBR needs fine screens sized to its membrane type and grease removal when influent fats, oils and grease reach 100 mg/L.
A process the rule does not cover is innovative or non-conforming technology under §217.7. It needs TCEQ's written approval before construction, and TCEQ may require a pilot study or performance data and a performance bond covering at least two years.
How do flows and loadings set the size?
From Chapter 217's design basis, not the unit's nameplate. Under TCEQ's design flow rule, 30 TAC §217.32, a new plant under 1.0 MGD uses a design flow of at least 1.5 times the average annual flow from TCEQ's per capita table. Without site data, peak flow is at least 4.0 times the design flow, and every flow-limited unit must handle the peak.
Loading matters as much as flow. The design organic load comes from actual data or from TCEQ's table by type of use. A development that adds restaurants, a car wash or an industrial tenant after startup changes the load the plant was sized for.
A unit sized correctly for domestic waste then misses its effluent limits on waste it was never sized for. Our post on sizing a package plant for a new Texas development walks through the numbers.
When does a package plant cause problems?
Usually when the brochure set the design basis instead of the project. The common failures:
- The design goes in with manufacturer data but no calculations showing it meets the permit limits at design and peak flows.
- The loading changes after occupancy, when commercial or industrial tenants move in.
- The development outgrows the unit. A second unit works, but the hydraulics, solids handling and controls were not laid out for parallel trains.
- A remote site with thin operator coverage gets a process that needs close attention.
The package unit is rarely the problem. Buying it before the design basis is set is.

How do you decide which one fits your project?
Answer each item yes or no. If every answer is yes, a package plant is a reasonable candidate. Any "no" means process engineering comes before equipment selection.
- Is the design flow, with its peak, inside the range the unit is built for?
- Is the waste domestic, with no industrial or high-strength stream now or planned?
- Can a standard process meet the permit's effluent limits, including any nutrient limits, with margin?
- Does the unit's configuration meet Chapter 217 as written, with no variance or innovative technology approval?
- Is growth covered by phases the permit allows, with room for a second train?
- Will the site get the operator coverage the process needs?
Bring the answers to your engineer before anyone signs a purchase order.
Limits: this is general education on Chapter 217 as it reads in October 2026, and EPA's package plant figures date from 2000. Your flows, waste stream and permit limits decide the actual design, and nothing here predicts a review outcome.
Frequently asked questions
Will TCEQ accept a package plant?
Yes, if the design meets Chapter 217 and the permit's effluent limits. A package plant goes through the same summary transmittal letter and possible full review as a custom design.
Can a package plant be expanded when the development grows?
Within the unit's rated capacity, yes. Beyond it, expect a parallel unit. Chapter 217 also requires construction to follow the phases in the permit, with plans approval for each phase before it is built or operated.
I'm developing a subdivision in Central Texas and a vendor quoted a package SBR. What should my engineer check before we commit?
The design and peak flows from §217.32, then the unit itself against §217.156: the number of tanks, the side water depth, decant capacity with the largest basin out of service and sludge digestion. Then confirm it meets the permit limits with margin.
I'm a civil engineer in Texas on a mixed-use project with a brewery tenant. Can a standard package plant handle the combined flow?
Not without characterizing the brewery's flow and strength first. High-strength waste changes the organic load the plant is designed for. Size the process from that data, and confirm early with TCEQ how the permit will treat the industrial stream.
