Force main corrosion in Florida's coastal environment: design strategies that last

Coastal Florida force mains corrode from sulfide, saline groundwater and long detention. Material, hydraulics and dosing extend a main's life.

Updated · First published

Quick answer

Force main corrosion in Florida's coastal environment comes from two sides at once. Inside, warm wastewater sitting in a full pipe turns anaerobic and generates hydrogen sulfide. Outside, brackish groundwater and a high water table attack metallic pipe and fittings.

A main designed for hydraulics alone is more likely to fail early. Choose the material for the environment, keep detention time short, protect against surge, and inspect the highest-risk segments before they break.

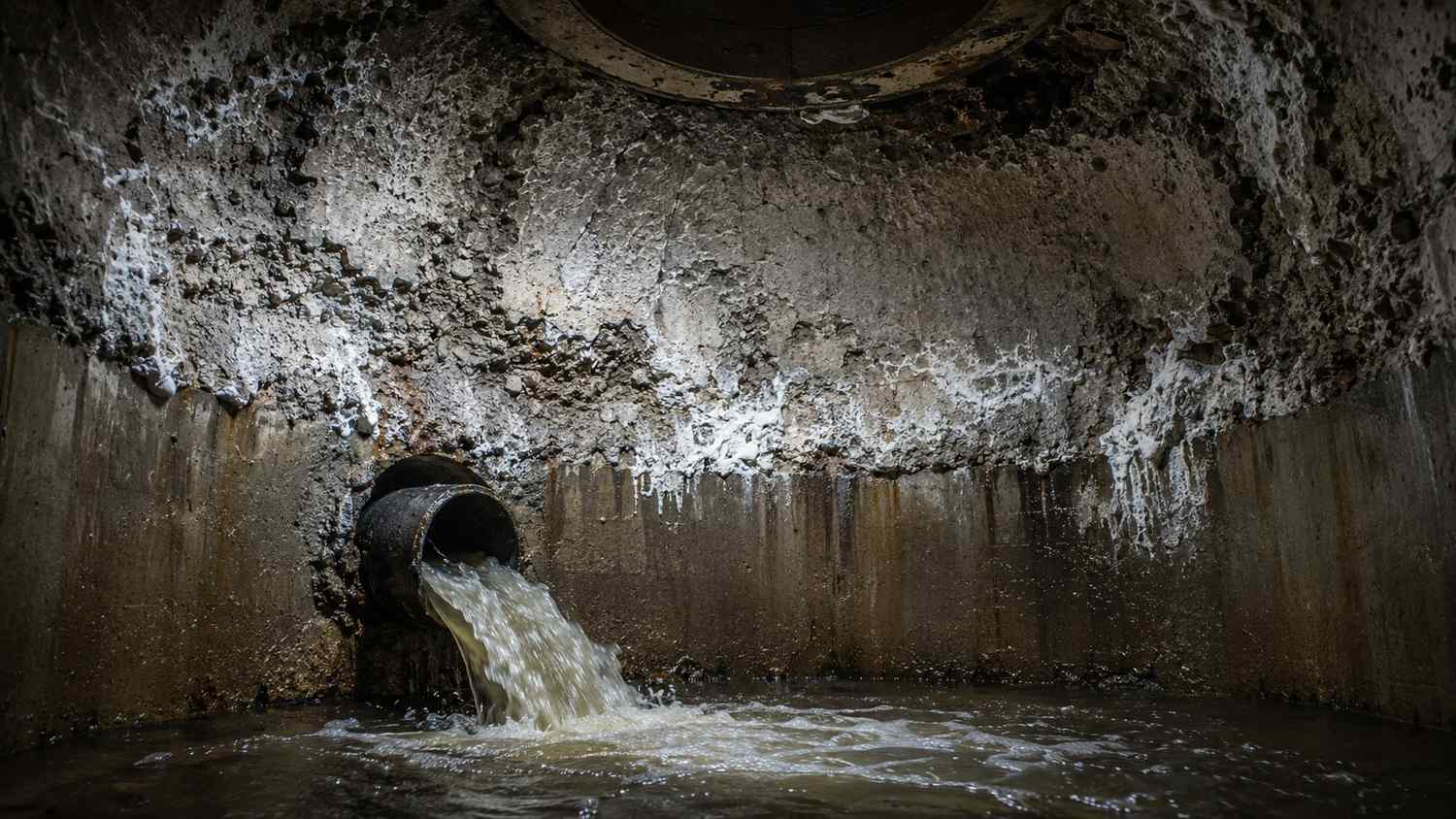

Corroded concrete manhole crown at a force main discharge.

Why is coastal Florida so hard on force mains?

Because several corrosion drivers stack up in the same place. Coastal groundwater is often brackish, and chlorides speed external corrosion of ductile iron, steel and metal fittings. A high water table keeps buried pipe wet year-round.

Any defect works both ways. Infiltration lets corrosive groundwater in. Exfiltration puts wastewater into ground that is connected to coastal waters.

A failure is also expensive in every sense. Repairs mean dewatering in high groundwater, and a spill is a reportable event. Under FDEP's wastewater incident reporting rules (opens in a new tab) (Rules 62-620.610 and 62-604.550, F.A.C.), a spill over 1,000 gallons, or one that may threaten health or the environment, goes to the State Watch Office within 24 hours of discovery, with a written report within five days. Smaller spills still go to the DEP district office or delegated local program.

How does hydrogen sulfide attack a force main?

A force main runs full, so oxygen runs out and sulfide builds. As wastewater moves through a pressurized pipe with no air space, bacteria use up its dissolved oxygen. Under anaerobic conditions, sulfate-reducing bacteria in the slime layer on the pipe wall convert sulfate to sulfide.

The EPA design manual on odor and corrosion control in sanitary sewerage systems (opens in a new tab) (1985) identifies hydrogen sulfide as toxic and corrosive to sewer construction materials, and treats detention time in force mains as a key driver of sulfide buildup. Heat matters too: the manual reports sulfide production rising about 7 percent per degree Celsius, up to 30 degrees, so warm Florida wastewater makes more of it.

The worst damage often shows up downstream. When the pressure drops at the discharge, hydrogen sulfide leaves the water as gas and attacks concrete and metal above the waterline in the receiving manhole and the gravity sewer. Inside the main, an unprotected or damaged lining exposes the pipe wall to the same attack.

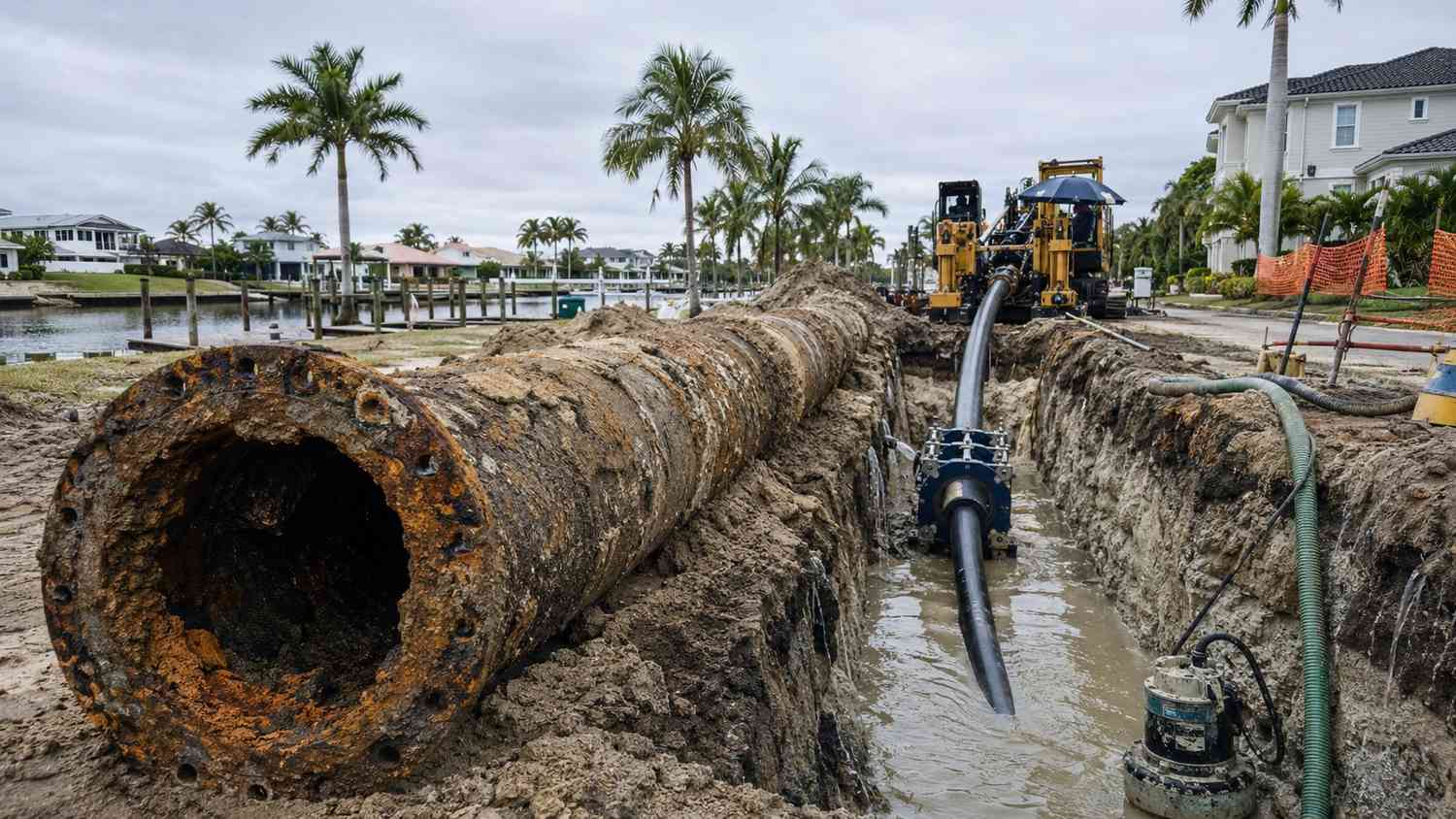

A corroded ductile iron pipe section next to a new HDPE pipe section.

Which pipe material holds up best?

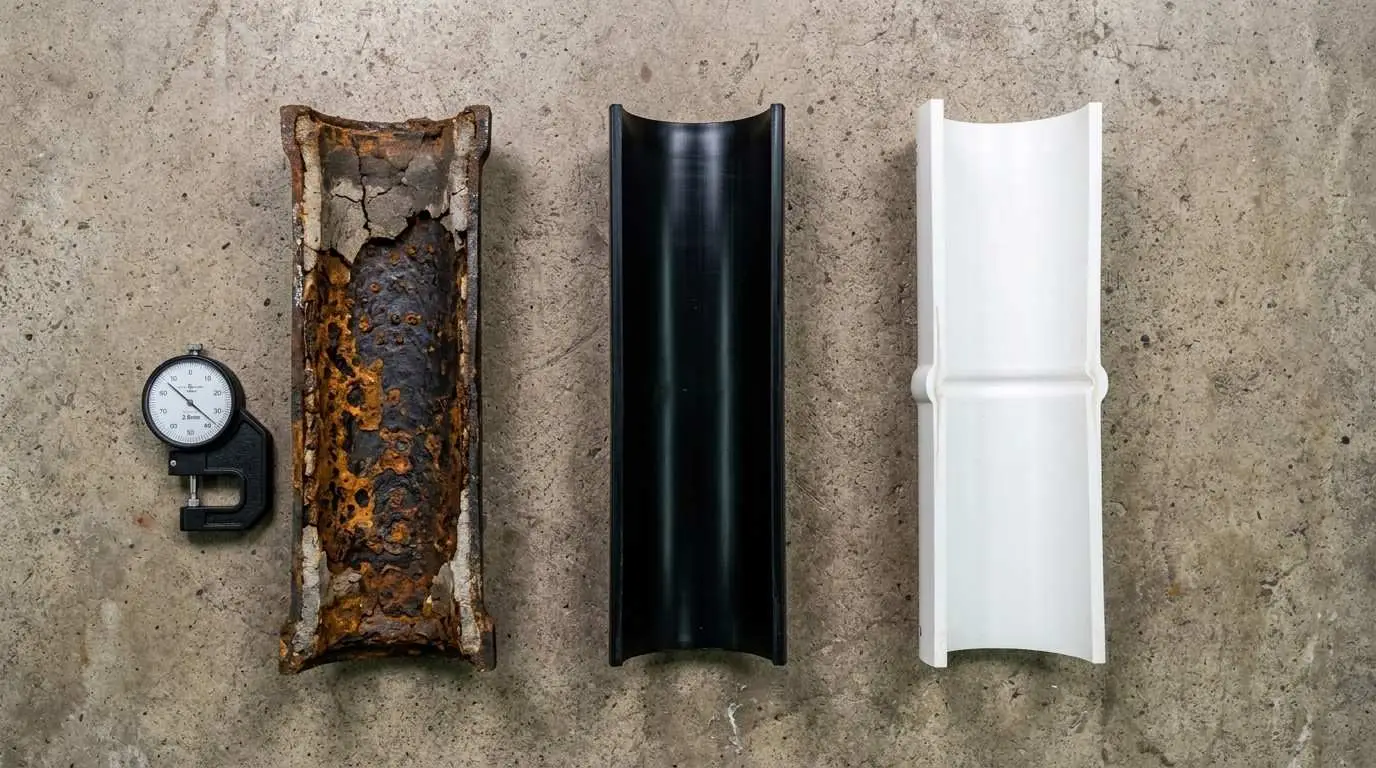

Material selection is the most important corrosion decision you make. The common force main materials each have a place, and the right one depends on pressure, soils, groundwater, installation method and how the utility maintains its system.

  • Ductile iron is strong, handles surge well and is familiar to crews. In coastal soils it needs external protection, such as polyethylene encasement under AWWA C105, and an intact interior lining suited to sewage.
  • HDPE resists sulfide and soil corrosion, and its fused joints make a continuous, restrained pipe. It needs trained fusion crews and careful handling, and its pressure class depends on wall thickness. Our post on When HDPE pipe is the right choice for small water lines and force mains covers the basics.
  • PVC pressure pipe resists corrosion. Gasketed joints are its weak point, which fusible PVC addresses with fused joints.
  • Fiberglass reinforced pipe resists corrosion with a high strength-to-weight ratio, and is usually reserved for large or very aggressive applications.

Plastic pipe pressure ratings are tied to a reference temperature, so check the rating at the wastewater temperatures your main will actually see.

How does hydraulic design affect corrosion?

Velocity keeps solids moving, and short detention limits sulfide. The Recommended Standards for Wastewater Facilities (opens in a new tab) (2014), which FDEP lists as guidance under Rule 62-604.300, F.A.C. (opens in a new tab), call for a cleansing velocity of at least 2 feet per second at design pumping rates and recommend no more than 8 feet per second.

Velocity alone does not stop sulfide. The EPA manual says sulfide production is not directly altered by velocity, and a main flowing at 4 feet per second showed buildup no different from slower ones. Detention time is what you control, so an oversized main or long pump-off periods add sulfide. Weigh the energy saved by a larger pipe against the corrosion it can cause.

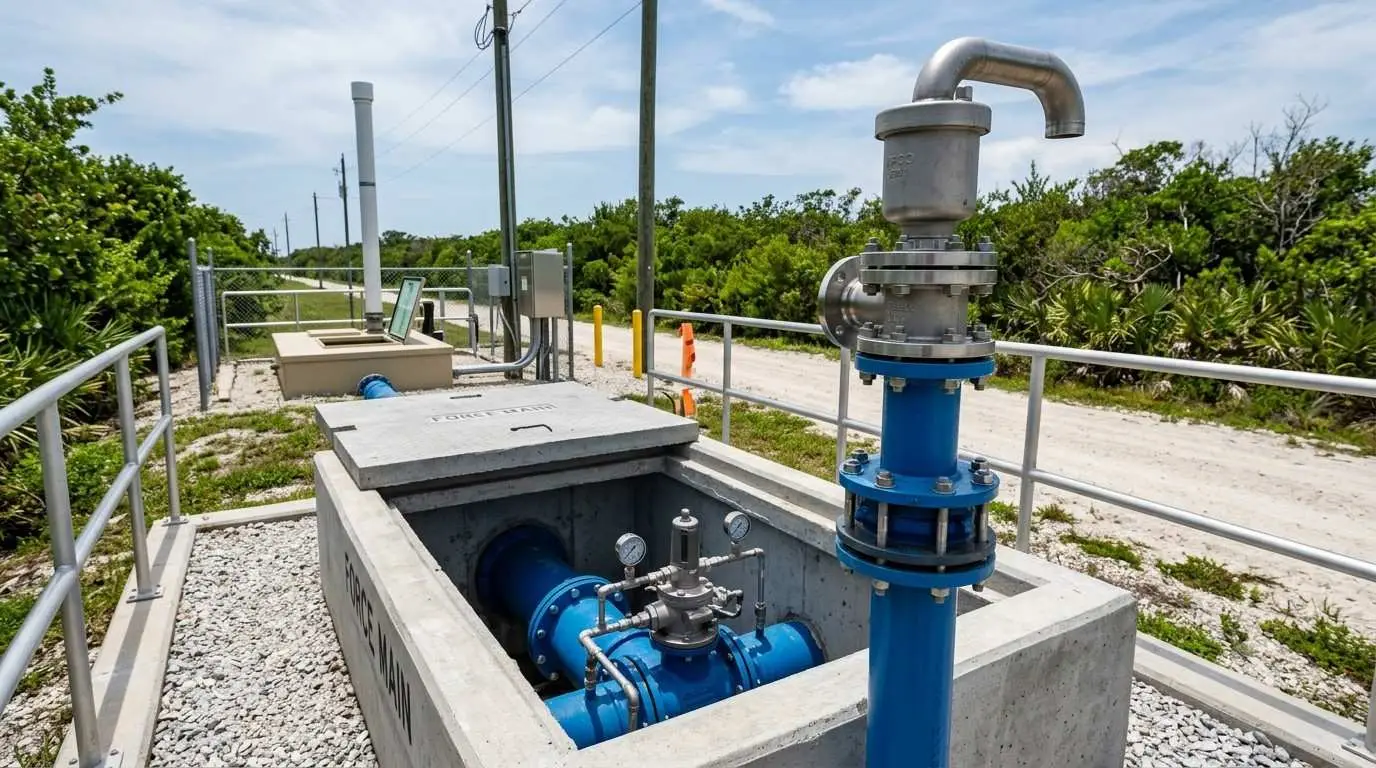

The same standards require air relief valves at high points to prevent air locking. On the coast, specify valve bodies, hardware and vaults for external corrosion, because a seized valve can hide until pumping capacity drops.

Design for surge. The standards require the force main and its restraint to withstand water hammer and cyclic pressure reversals, and call for evaluating surge valves, surge tanks or other protection. Analyze pump starts, stops and power failure, then size the protection for that system.

They also require corrosion protection inside the receiving manhole where septic conditions are expected. Plan that manhole as part of the force main, not as an afterthought.

How should a utility inspect and manage existing force mains?

Start with the segments most likely to fail and most costly if they do. Prioritize long detention, high sulfide exposure, the oldest ductile iron, and any history of leaks or repairs.

The usual tools are acoustic leak detection, internal camera inspection through access fittings, pipe wall thickness measurement, and pressure testing. The right mix depends on the material, the age and the consequence of failure along the route.

Turn the findings into a ranked rehabilitation and replacement plan. Where a main can be rehabilitated rather than replaced, see how a CIPP lining approach works for failing force mains (a Colorado example).

What can be done for a main that cannot be replaced yet?

Control the sulfide chemistry. The EPA manual covers several methods for force mains:

  • iron salt dosing at the wet well, which ties up sulfide as iron sulfide;
  • air or pure oxygen injection to keep the wastewater aerobic;
  • nitrate addition, which suppresses sulfide generation;
  • pH elevation, including caustic shock dosing;
  • oxidants such as hydrogen peroxide or chlorine.

Each needs feed equipment, monitoring of sulfide at the discharge manhole, and an operating budget. Dosing slows corrosion and odor. It does not restore pipe that has already lost wall.

Is your force main design ready for the coast?

Any "no" is a design item to resolve before the main is bid.

  1. Has the soil and groundwater corrosivity along the route been tested?
  2. Was the pipe material chosen for that environment, not just for pressure?
  3. Have you estimated detention time at low and average flows?
  4. Is there a surge analysis covering power failure?
  5. Are air relief valves and vaults specified for coastal exposure?
  6. Is the receiving manhole protected against hydrogen sulfide?

This article is general education based on the public sources linked above. Standards, FDEP rules and site conditions vary, and corrosion behavior depends on your wastewater. Your design engineer and FDEP make the final call on your project.

Frequently asked questions

What causes force main corrosion in Florida?

Hydrogen sulfide from anaerobic wastewater inside the main, and brackish, chloride-rich groundwater outside it. Warm temperatures and long detention times make both worse.

Does a force main spill have to be reported in Florida?

Yes. FDEP says a spill over 1,000 gallons, or one that may threaten health or the environment, is reported to the State Watch Office within 24 hours of discovery, with a written report within five days. A smaller spill is reported to the DEP district office or delegated local program.

How do we decide which old force mains to replace first?

Run a condition assessment. Rank segments by detention time, sulfide exposure, age and leak history, then test the top ones with leak detection and wall thickness measurement. The results support a ranked capital plan.

For a new coastal force main, is drilled HDPE better than open-cut ductile iron?

For corrosion, HDPE avoids both sulfide and soil attack, and drilling avoids dewatering a deep trench in high groundwater. Weigh that against pressure class, fusion and handling needs, and what the utility will accept.

How do we manage hydrogen sulfide in a long force main we cannot replace soon?

Chemical control: iron salts at the wet well, oxygen or air injection, or pH adjustment, with sulfide monitoring at the discharge. It reduces corrosion and odor but does not repair damaged pipe.

Worried a coastal force main will fail early?

We help Florida utilities and developers design force mains for the environment they sit in, and plan the fixes for the ones already in the ground. MES is licensed in Florida. Talk to an engineer about your force main.
