How Modeling Wastewater Treatment Processes Saves Resources and Money

Wastewater treatment process modeling saves money when it is calibrated to the plant's own data and used to test aeration, chemical and expansion decisions.

Quick answer

Wastewater treatment process modeling builds a mathematical copy of a plant that predicts effluent quality, energy use and sludge under loads the plant has not seen yet. It saves money by testing aeration, chemical and capital decisions before anyone pays for them. Its value depends on the data behind it: a model not calibrated to the plant's own records is an educated guess.

Wastewater Management

What is a wastewater treatment process model?

A set of equations that tracks what the plant's biology, hydraulics and equipment do to the wastewater. The biological core of most activated sludge models comes from the International Water Association's model family: ASM1 and its successors ASM2, ASM2d and ASM3, published together in IWA's 2000 Scientific and Technical Report No. 9.

Hydraulic models route flow through the plant's channels, weirs and pipes. Energy models track power use by process unit. Most questions need one of the three, not all of them.

The model also has to match the process. Activated sludge, SBRs, MBRs and lagoons behave differently, and a small package plant needs far less detail than a large municipal plant. Match the model to the decision being made and the results stay useful.

Why does calibration decide whether a model is useful?

Because default parameters describe a typical plant, not yours. Calibration adjusts the model until it reproduces the plant's own records: influent characterization, effluent monitoring and operating data. Only then is it fit for prediction.

Texas already asks for that kind of data for some decisions. When an existing plant is re-rated or altered, TCEQ's design basis rule for existing plants, 30 TAC §217.34, requires the last five years of flow data from a totalizing meter. Organic loading comes from at least three composite influent samples a week for at least a year, in wet and dry weather.

The same rule says projected peak flow must come from collection system monitoring or modeling based on a two-year, 24-hour storm. A calibrated model runs on the same data set, so collect it once and use it twice.

How does modeling cut operating costs?

Mostly through aeration, the largest energy user in most activated sludge plants. EPA's 2010 report on energy conservation measures for wastewater facilities puts aeration at 25 to as much as 60 percent of total plant energy, citing the Water Environment Federation.

The same report cites WEF and ASCE estimates that tight dissolved oxygen control can save 10 to 30 percent of total energy costs. Savings are site specific and depend on the controls already in place.

A calibrated model shows how low dissolved oxygen can go at each load before nitrification or effluent quality suffers. It also tests chemical doses for phosphorus removal, disinfection and sludge conditioning, to find the lowest dose that still meets the permit.

Check the design rule before you redesign around a lower setpoint. Under TCEQ's aeration basin sizing rule, 30 TAC §217.154, an aeration system is designed to hold at least 2.0 mg/L of dissolved oxygen throughout the basin at the maximum diurnal organic load. TCEQ may accept other values for nutrient removal designs or tapered aeration for energy conservation, with written approval.

How do models help plan an expansion?

They show which unit runs out of capacity first. Texas sets the clock. Under TCEQ's permit rule, 30 TAC §305.126, when flow reaches 75 percent of the permitted flow for three consecutive months, the permittee must start engineering and financial planning for expansion. At 90 percent for three months, it must obtain authorization to construct.

A model run at projected flows shows whether the aeration, clarifiers and disinfection will hold the permit limits, or which one becomes limiting before the plant reaches its design flow.

That changes the capital plan. Instead of expanding everything, the results may show that only aeration and the secondary clarifiers need work at the next step, while the headworks and disinfection have margin. Our post on capital improvement planning for small municipalities covers where that plan starts.

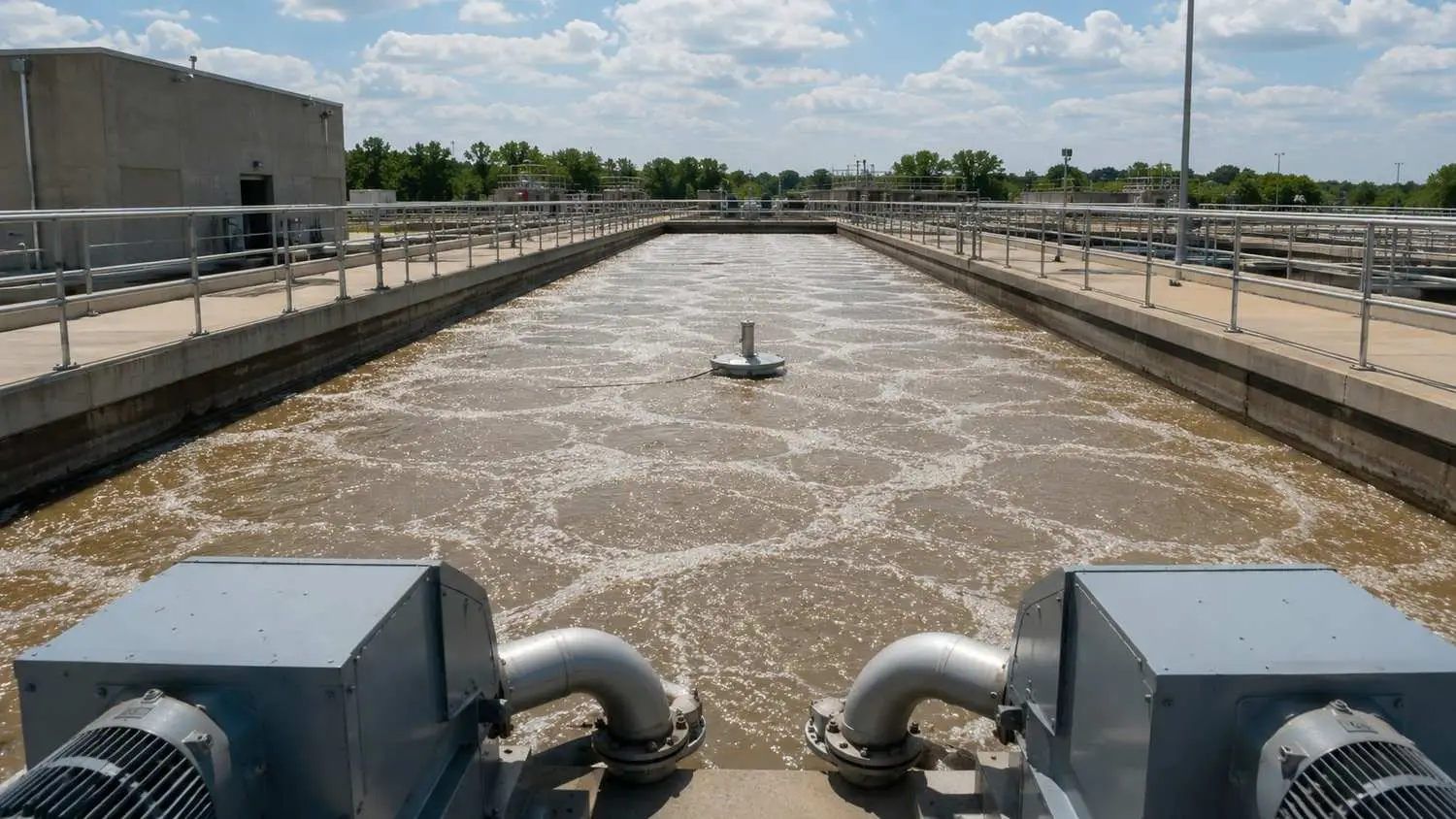

Wastewater treatment plant aeration basin with active biological treatment showing diffused air bubbling through mixed liquor with blower equipment and dissolved oxygen monitoring instrumentation visible

Does a process model help with a new plant's design?

Yes, as a check that the chosen process meets the permit limits across the loads it will see. Under TCEQ's submittal rule, 30 TAC §217.6, the plans must be based on a design that at least meets the permit's effluent limits, and the engineer certifies compliance with Chapter 217.

A model tests that at design flow, peak flow and cold-weather temperatures before equipment is bought. It is most useful with tight nutrient limits, reuse quality targets or loading that changes a lot between phases.

It does not replace the rule. Chapter 217 still sets the design flows, loadings and unit sizing criteria, and any departure is a variance the engineer must justify. No model guarantees a faster review.

Is your plant ready for a modeling study?

Answer each item yes or no. If every answer is yes, a calibrated model is within reach. Each "no" tells you which data to start collecting.

  1. Do you have at least a year of influent sampling for BOD or CBOD, TSS and ammonia, in wet and dry weather?
  2. Is flow measured with a totalizing meter, with several years of records?
  3. Do you have the effluent monitoring data your permit requires?
  4. Do you have records of aeration settings, blower run times and chemical use?
  5. Is the decision defined: energy, chemicals, re-rating, expansion or a new design?
  6. Do you know your current flow as a share of the permitted flow?

Then ask your engineer which decision the model should answer first.

Limits: this is general education. The energy figures are national ranges EPA cites from industry sources, not a prediction for your plant, and the TCEQ rules are as they read in October 2026.

Frequently asked questions

What software is used for wastewater treatment process modeling?

Commercial biological process simulators built on the IWA activated sludge models are the usual tools. EPA's free Storm Water Management Model covers sanitary and combined sewers, and EPANET models pressurized drinking water networks. Neither models the treatment process itself.

How accurate are wastewater treatment process models?

As accurate as the data used to calibrate them. A model adjusted to match the plant's own influent, effluent and operating records predicts far better than one run on default values.

I manage a small city's wastewater plant in Texas that has been at 75 percent of its permitted flow for three months. Can a process model help before we commit to an expansion?

Yes. The rule already requires you to start engineering and financial planning. A calibrated model run at projected flows shows which units limit first. If growth will not exceed the plant's design, §305.126 lets you submit an engineering report and seek a written waiver.

I'm an engineer designing a new Texas plant for a development with an uncertain build-out. Is a process model worth it at the design stage?

It is worth most when the loading will change a lot between phases or the permit has tight nutrient limits. The model tests the process across that range. Chapter 217's sizing criteria still apply either way.
