210E reclaimed water authorizations for Texas developments

A 210E needs an industrial wastewater stream. Our four took 4 to 10 weeks, where nearby discharge permits took 30+ months. We check eligibility first.

Talk to an engineer or call (214) 833-6748

When a 210E fits

A 210E authorization is TCEQ's written approval to reuse industrial wastewater, alone or mixed with domestic sewage, for irrigation and other approved uses instead of discharging it. It does not fit every site. It needs:

  • An industrial wastewater stream that 30 TAC §210.54 does not exclude. Hazardous wastewater, most categorical process wastewater and grease trap waste are out.
  • A place for the water to go every day: reuse land you control, or a signed agreement with the user.
  • A backup disposal method for the days reuse stops.

An all-domestic project cannot use 210E, and a mixed-use project qualifies only through its industrial stream.

Why developers ask about it

  • The county denied a septic permit.
  • A discharge permit carries public notice and a possible contested case hearing. Nearby discharge permits our staff watched took 30+ months.
  • The project has an industrial tenant or process but no clear wastewater path.

The 210E application itself has no public notice step; any companion permit has its own. That is where most of the time difference comes from.

What we do

  • Check eligibility: the stream, the exclusions, and whether it is commingled with domestic sewage.
  • Build the reuse plan: end uses, irrigation area and a water balance, with storage sized for the days you cannot irrigate.
  • Name the backup. A backup that discharges needs its own permit.
  • Prepare the application on Form TCEQ-20094 and answer TCEQ's questions.
  • Design the system: the storage pond, irrigation pump station and distribution.

One rule to check before you schedule

Where domestic sewage is mixed in, 30 TAC §210.2(e), effective March 2025, may also require a discharge permit or a land application permit. We confirm the path with TCEQ before design, and before you build a schedule on it.

Results

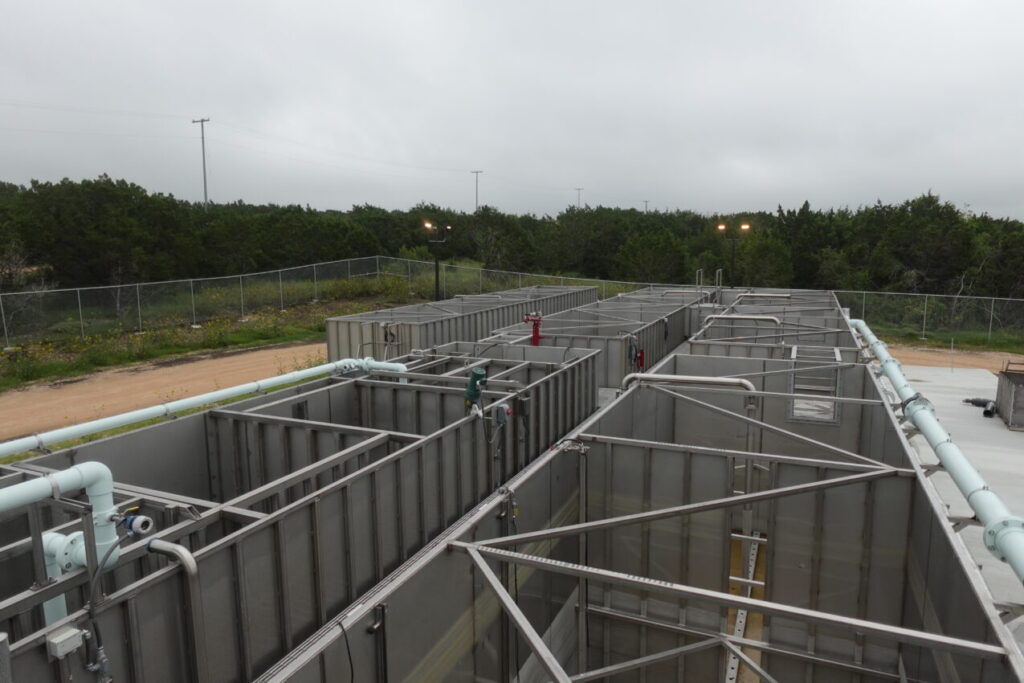

Four MES-led 210E authorizations. They show what an eligible, complete application can do, not what every project will get:

Questions developers ask

Does a 210E replace a discharge permit?

For a purely industrial stream, §210.56(a)(3) waives the treatment and disposal permit. Where domestic sewage is mixed in, §210.2(e) may also require a discharge permit or a land application permit, so confirm with TCEQ. If the backup disposal is a discharge, that backup needs a permit under 30 TAC Chapter 305, and a backup permit that has not been issued does not cover day one.

How much of the flow has to be industrial?

There has to be an industrial stream, but the rule sets no percentage. Industrial wastewater with any domestic wastewater in it is commingled (§210.52(3)) and eligible for Level II (§210.53(b)(2)). The plant then has to meet the stricter commingled quality standard.

What happens if the reuse user stops taking water?

The water goes to the backup disposal method named in the application. That is why we settle the backup and the reuse agreement before you file.

Is this Texas only?

Yes. 210E is a Texas rule (30 TAC Chapter 210, Subchapter E), administered by TCEQ.

More detail: 210E reclaimed water authorizations in Texas and 210E vs TPDES, side by side.
