Municipal Utility Districts in Houston Suburbs: When to Form One and When to Use a Developer-Owned Treatment Plant Instead

A municipal utility district suits large Houston-area projects with long buildouts, while a developer-owned plant often fits smaller or faster ones.

Quick answer

A municipal utility district fits large Houston-area projects with a long buildout, where bonds can fund water, sewer and drainage up front and the future tax base repays them. A developer-owned treatment plant fits smaller or faster projects, or an owner who wants to keep control. Check first whether an existing district or city can serve you, because that can make both moot.

Why is a MUD the default answer in Houston's suburbs?

Because it solves the hardest problem in suburban development: paying for infrastructure before there is anyone to pay for it.

A MUD is a local government, not a financing product. TCEQ's water districts page (opens in a new tab) calls a water district "a local, governmental entity that provides limited services to its customers and residents." TCEQ supervises districts and reviews the bonds that finance certain district infrastructure.

Once a district exists and voters approve bonds, it can sell them to build water, wastewater and drainage facilities, then repay them from property taxes on the homes and businesses built inside it. In greater Houston, where growth has long run ahead of city annexation, that model built a large share of the suburban map. A MUD developer partnership is one way to set it up.

Houston area master planned community water and sewer infrastructure under construction.

What does forming a MUD actually involve?

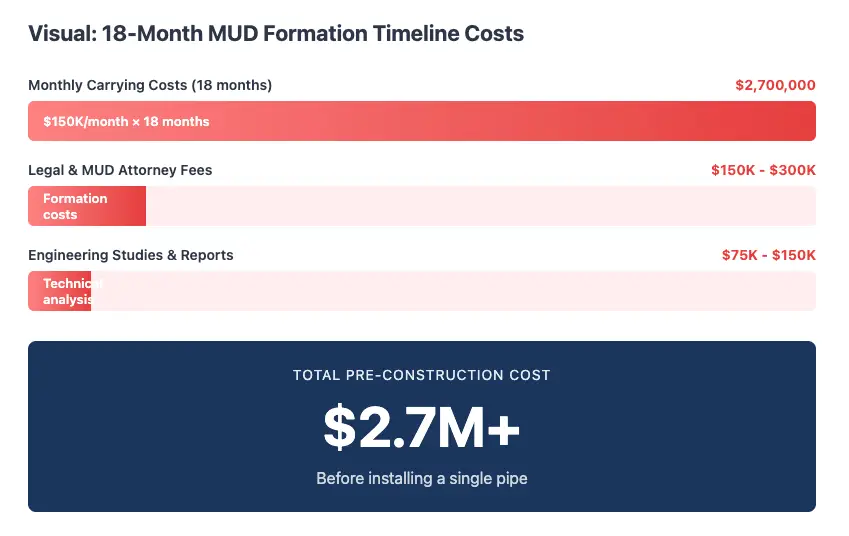

A petition, consent, an election and a bond review, each with its own approvals. None of it is quick, and none of it starts the plant.

  • Creation. Under Water Code Chapter 54 (opens in a new tab), a petition signed by a majority in value of the landowners is filed with TCEQ (§54.014). The Legislature can also create a district by special act.
  • City consent. Land inside a city or its extraterritorial jurisdiction (ETJ) needs the city's written consent (§54.016). In the ETJ there is a fallback: if the city does not consent within 90 days, owners can ask it to provide the service instead, and if no service contract follows, they can petition TCEQ.
  • Confirmation election. Under Water Code §49.102, the district holds an election to confirm its creation before it issues bonds.
  • Bond review. Under §49.181, TCEQ approves most district bonds after finding the project feasible, based on the engineer's report and its own staff review.

The developer still carries the early money. The district reimburses eligible costs from bond proceeds after the fact. TCEQ's rules can also require the developer to fund at least 30% of certain district construction costs (30 TAC §293.47 (opens in a new tab)). Some facilities, wastewater treatment plants among them, are exempt from that share.

Where does the MUD default break down?

On small projects, fast schedules and owners who want to keep control.

The process has a fixed cost that does not shrink with the project. Counsel, a financial advisor, an engineer's report, elections and a bond sale take much the same work for 200 lots as for 2,000. On a small tract, the tax base may never carry it.

Bonds arrive after the infrastructure does. A project that needs sewer service for its first homes next year cannot wait for the bond proceeds that would reimburse it. The developer funds the first phase either way.

A district governs for decades. It has an elected board, open meetings and public records, and the state supervises it. That is the point for a large community. It is overhead for a developer who wants to run the utility as part of the business.

When is a developer-owned treatment plant the better fit?

When the project is too small or too fast for district financing, and no existing system will serve it on workable terms.

The developer designs, permits, builds and initially owns a private wastewater treatment plant, funded from the project's own capital. The plant needs a TPDES permit to discharge or a Texas Land Application Permit (TLAP) to irrigate, as TCEQ's domestic wastewater permits page (opens in a new tab) explains.

Private does not mean easy. TCEQ's regionalization review (opens in a new tab) asks every permitted system within three miles about service, and a nearby district with capacity can make you justify building instead of connecting. Selling sewer service to the public also takes a certificate of convenience and necessity (CCN) from the Public Utility Commission under 16 TAC §24.225 (opens in a new tab).

Developer-owned private wastewater treatment plant on Houston area development site.

Can an existing district or city serve you instead?

Ask this first. Annexing into an existing MUD, or a service agreement with a neighbor that has capacity, is often faster than either building path.

Send written service requests to every district, city and utility near the site during feasibility. Ask for remaining capacity, the cost to join and any conditions. The replies go into a TCEQ permit application anyway if you end up building a plant, so the work is never wasted.

How do project size and phasing change the answer?

Size sets the tax base, and phasing sets how long you can wait for bonds.

A master planned community with thousands of homes and a decade-long buildout has the tax base to repay bonds and the runway to form a district while early site work proceeds. A few hundred homes, a commercial pad site or a light industrial park often do not. Run the numbers with bond counsel and a financial advisor; no lot count works as a rule.

Phasing can combine the two. Some developers start with an interim private plant for the first phases while a district forms, then convey the plant to the district. That works only if the plant, its permit and its contracts are set up for the transfer from day one.

How does reuse affect the choice?

Reuse works under either owner, but the rules come from the water's source, not from who owns the plant.

Treated domestic wastewater used for golf course or common area irrigation is reclaimed water under Subchapters A to C of 30 TAC Chapter 210 (opens in a new tab). The provider needs TCEQ's written approval before supplying a user (§210.4), and the plant still needs its own permit. Subchapter E, the path behind a 210E authorization, covers industrial reclaimed water, so it is not the path for a subdivision plant.

A developer who owns the plant controls the reuse system as an amenity. Under a district, the board and its operator run it. Either works; decide who you want answering for it in year ten.

Are you ready to choose a path?

You are ready when you can answer yes to all five.

  1. Have you asked every nearby district, city and utility for service in writing?
  2. Does the projected tax base at buildout carry the bonds, per your financial advisor?
  3. Can the first phase wait for district creation and its first bond sale, or will you fund it either way?
  4. Do you know who will hold the plant permit, any CCN and the operator contract?
  5. If you start private, is the plant set up to transfer to a district or utility later?

A note on limits: this is general education from the Texas Water Code, TCEQ and Public Utility Commission rules and guidance as published in October 2026. District formation is legal and financial work as much as engineering, so your attorney, financial advisor and engineer should decide it together for your site.

Frequently asked questions

Who creates a municipal utility district in Texas?

TCEQ, on a landowner petition under Water Code §54.014, or the Legislature by special act. For a district created through TCEQ, land in a city or its ETJ also needs the city's consent.

Does a MUD pay for everything the developer builds?

No. It reimburses eligible costs from bond proceeds, after TCEQ approves the bonds. TCEQ rules can require the developer to fund at least 30% of some construction costs.

I'm planning 300 homes in an unincorporated part of Fort Bend County and my lender is asking whether we need a MUD. How should I frame the decision?

Start with service: ask nearby districts and utilities whether they can take your flow. If none can, compare the cost and schedule of forming a district against funding a private plant yourself. Have a financial advisor test whether 300 homes carry the bonds.

I'm a homebuilder with a private package plant serving our first phase. Can a MUD formed later take it over?

Often, if the plant was built to the district's standards and its permit, operator contracts and easements can transfer. Plan the conveyance before you build, and confirm with district counsel which costs qualify for reimbursement.
