Pretreatment Equipment Sizing for Texas Facilities Facing New Local Limits

Pretreatment equipment sizing for new local limits in Texas starts with measured peak flow and mass loading, since the old design margin is gone.

Quick answer

Pretreatment equipment sizing for new local limits starts with measured data, not the old design basis. When a Texas POTW tightens a limit, a system that met the old number can fall short with no change in production, because it was sized to the margin the old limit allowed.

Size the upgrade to measured peak flow and peak mass loading against the new limit, with margin, and ask the city for a compliance schedule while you build it.

Why do local limits change when my plant hasn't?

Local limits protect the city's plant, so they move when the city's plant changes. Under 40 CFR §403.5(c), a POTW with a pretreatment program must develop and enforce specific local limits, and keep developing them as needed.

In Texas, TCEQ's technically based local limits page says a POTW with an approved program must reassess its existing limits within 60 days after its TPDES permit is issued, renewed or amended. The requirement is written into the POTW's own TPDES permit, not a stand-alone rule. TCEQ also lists events that may call for a new look:

  • The POTW expands
  • New commercial or industrial customers connect, or existing ones disconnect
  • The POTW's options for handling sludge change
  • Monitoring shows noteworthy variation in pollutants of concern

So a new permit for the city's plant, a stricter stream standard, or a large new neighbor on the same sewer can each tighten the number at your connection.

Why does an unchanged system suddenly fall short?

Most systems were sized to the old limit, not to the facility's real worst day. A looser limit hid the gaps. A tighter one exposes them. The same weak points show up again and again:

  • Equalization tanks sized to the margin the old limit allowed
  • pH systems sized to average flow, not the peak events that drive excursions
  • Dissolved air flotation units sized from a vendor curve, not measured loading
  • Chemical feed pumps and storage sized for the original dose
  • Sludge handling that cannot take the extra solids better removal creates
  • Manual control where the process needs automatic response
  • No flow meter and poor sampling points, so nobody knows the real peaks

The last item matters most. Without good data, you cannot tell which of the others is the real problem.

What data does a resizing analysis need?

Measure first, then size. A defensible sizing basis has five parts:

  1. Wastewater characterization across enough production cycles to capture how the discharge varies, not one good week.
  2. The real production schedule: shifts, batch dumps, cleaning cycles and seasonal runs.
  3. Peak flow and peak concentration, measured at a flow meter and a representative sampling point.
  4. Mass loading, flow times concentration, for each limited parameter. Many limits work out to mass, and concentration alone hides it.
  5. The new limits and permit conditions themselves, from the city in writing, plus what its pretreatment coordinator expects to see in the submittal.

If the facility has no flow meter, installing one is usually the first step of the upgrade, not the last.

Which treatment steps answer which limit?

Match the unit process to the parameter that is failing. The toolkit is standard. The sizing is where facilities get it wrong.

  • Flow equalization smooths peak to average swings that cause intermittent exceedances. Size it to the measured peaks.
  • pH adjustment needs chemical feed capacity and response time for the worst slug, not the average.
  • Screening and oil water separation protect the steps downstream from solids and free oil.
  • Dissolved air flotation handles fats, oils, grease and fine solids, sized to measured FOG and solids loading.
  • Filtration polishes TSS when the limit drops below what upstream steps reliably reach.
  • Chemical precipitation removes metals. Plan the sludge system for the extra solids it makes.

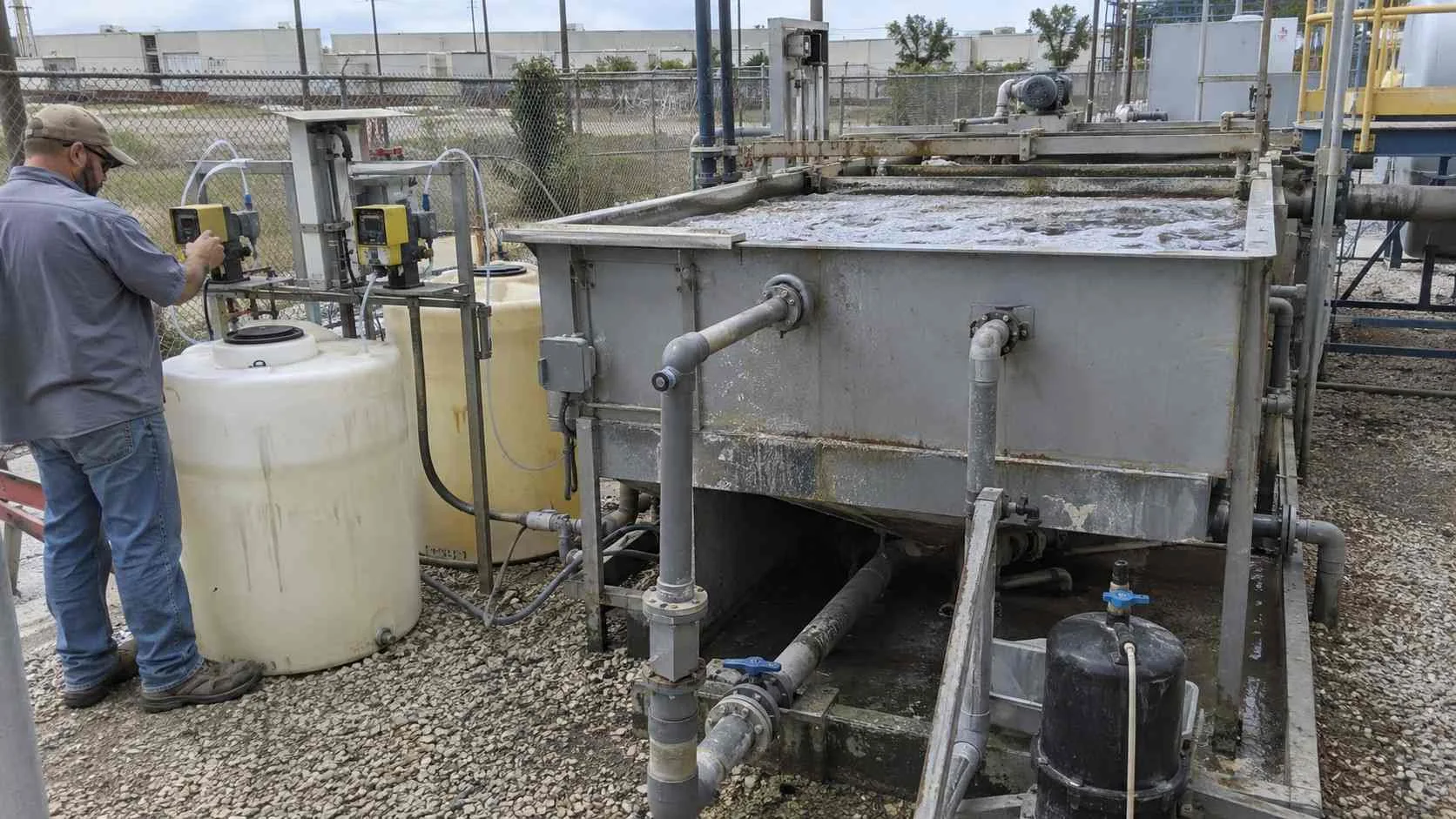

Dissolved air flotation and chemical feed system at an industrial facility

Automation often closes the last gap. A pH loop or equalization pump that responds on its own performs the same at 2 a.m. as at noon, and tight limits leave little room for the difference.

Can I get time to build the upgrade?

Ask for a compliance schedule in writing. Under 40 CFR §403.8(f)(1)(iii)(B), an industrial user permit includes effluent limits, monitoring and reporting requirements, and any applicable compliance schedule, which may not extend past an applicable federal deadline. A schedule sets dated milestones for design, purchase, construction and startup.

A schedule is the city's decision, not a right. Asking early, with a sizing analysis already in hand, gives the coordinator something concrete to approve. Waiting until after the first violation notice leaves less room.

The rules also run the other way. 40 CFR §403.12(j) requires every industrial user to notify the Control Authority promptly, and in advance, of any substantial change in the volume or character of its pollutants. If the upgrade comes with a production change, tell the city before startup.

Can I phase the equipment as production grows?

Yes, if the first phase is laid out for the second. Phasing works when the tank layout, the space, the chemical feed capacity and the control system are designed with the later units in mind. It works poorly when capacity is bolted onto a system never meant to expand.

Whatever the phasing, phase one has to meet the new limit at today's peak. Growth capacity is extra, not a substitute for margin now.

What are the limits of this guide?

This is general engineering guidance. Your local limits, your permit terms and any compliance schedule come from your POTW, and the TCEQ and federal rules cited here can change. Confirm the current limits and requirements with your city's pretreatment program before you design or buy equipment.

Frequently asked questions

How do new local limits affect an existing industrial facility?

They change the target your equipment has to hit. A system sized with margin under the old limit can lose that margin overnight, so a plant that changed nothing can start failing samples.

Why isn't a vendor quote enough to size pretreatment equipment?

A vendor sizes from a standard curve or a typical application. Your measured flow, peaks and mass loading may differ, and the gap shows up exactly when the limit tightens.

What is mass loading and why does it matter for sizing?

Mass loading is flow multiplied by concentration, the pounds of a pollutant per day. Two streams with the same concentration and different flows put very different loads on the equipment and on the city's plant.

I manage a Texas food plant and the city just sent new FOG and BOD limits. Should we buy a bigger DAF unit right away?

Not before you measure. Sample through full production and cleaning cycles, meter the flow, and compute peak loading against the new limits. The answer may be a larger DAF, more equalization ahead of the existing one, better chemical feed, or a mix.

I'm an environmental manager and our city is renewing its TPDES permit next year. Should we expect new local limits?

It is worth asking. A POTW with an approved program must reassess its local limits within 60 days after its TPDES permit is issued, renewed or amended, under a condition in that permit. Ask the pretreatment coordinator which parameters are under review and start collecting your own data now.
