Blog
Understanding water system design quotes: what you’re really paying for
Water system design quotes differ because scopes differ, so compare the hydraulic model, profiles, specs, TCEQ submittal and construction support before price.
Quick answer
Water system design quotes differ mostly because the scopes differ. One proposal pays for a hydraulic model, plan and profile sheets, specifications, a sealed state submittal and support during construction. Another pays for a pipe layout.
Line up the deliverables before you compare the totals. In our experience, the gap explains itself.
Why do water system design quotes vary so much?
Because two quotes for the same project rarely price the same work. Proposals for one water system can be far apart. They look like the same scope. They are not the same job.
A request that says "design the water system for the subdivision" leaves each firm to decide what that means. One reads it as a model, a construction set, specifications, the state submittal and help during construction. Another reads it as a layout a contractor can price.
Both quotes can be honest. Only one gets you a design a reviewer can approve and a contractor can build without stopping to ask questions. Experience moves the number too. A team that has built water systems prices in the problems that bite later, like a tie-in that crosses three other utilities.
What should a complete water system design include?
Five things: a hydraulic model, a full construction set, written specifications, a sealed regulatory submittal and construction-phase services. Leave one out and someone pays to fill the gap later. On a typical water distribution design, that looks like this:
- a hydraulic model that checks demands, pressures, fire flow and pipe sizes;
- plan and profile sheets with tie-in details, valves, hydrants and service connections;
- specifications that name the material, pressure class and standard for each item;
- the regulatory submittal, plus responses to review comments;
- construction-phase services: submittal review, contractor questions, site visits and the completion notice.
What does hydraulic modeling actually buy you?
Proof that the system meets pressure and fire flow before anyone digs. Without a model, pipe sizes are a guess.
A model built in a tool such as EPA's EPANET software (opens in a new tab) tracks the flow in each pipe and the pressure at each node. In Texas, TCEQ's water distribution rule, 30 TAC §290.44(d) (opens in a new tab), requires at least 35 psi at all points at flows of at least 1.5 gallons per minute per connection. Where the system is meant to fight fires, it must hold 20 psi under combined fire and drinking water flow. The model is how your engineer shows both.
It also finds the weak spots a layout hides: the high lots, the dead end, the last hydrant on a long main. Fixing those on paper means a bigger pipe or a loop. Finding them after construction can mean adding a booster pump station, which the same rule expects to draw from storage tanks.
That is why our ranch water system model and fire memo settled fire flow with the fire official first and then tested it in the model.
What does a plan-view-only drawing set leave out?

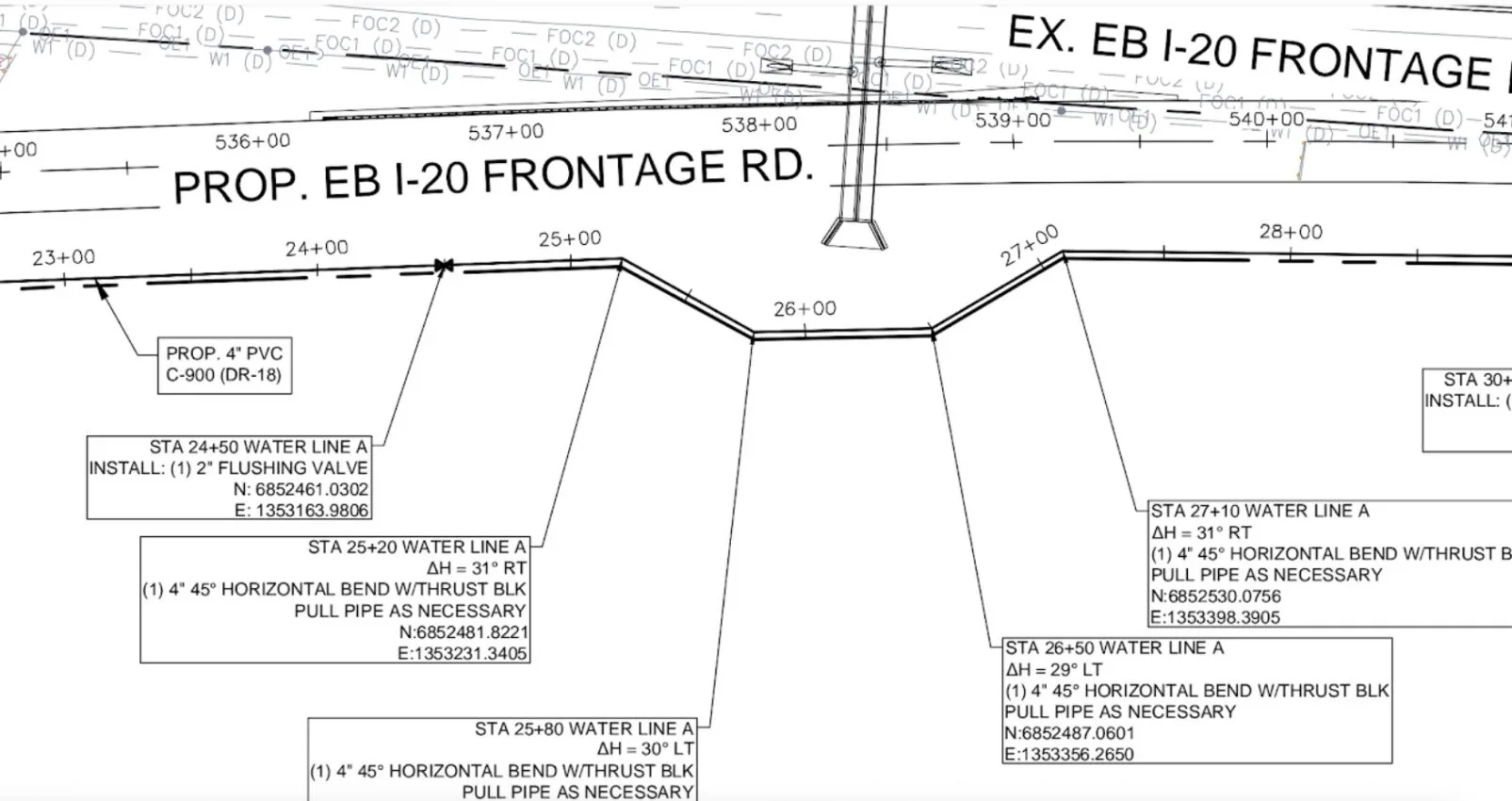

The vertical. A plan view shows where the pipe goes. It does not show how deep it sits, what it crosses or how it connects.
Profile sheets show cover, grades and every crossing with storm drains, sewers and other utilities. Section 290.44(e) also keeps new waterlines nine feet from wastewater collection facilities, with added measures where that cannot be met. A conflict caught on a profile is a design change. A conflict caught in the trench is a stopped crew and often a change order.
Specifications matter as much. The same rule requires AWWA standards, and plastic pipe must carry the NSF-pw seal and an ASTM pressure rating of at least 150 psi or a dimension ratio of 26 or less. A spec such as HDPE PE4710 DR 11 tells the contractor exactly what to buy. "4-inch pipe" does not.
Who reviews the design, and what does the state not check?
A licensed professional engineer prepares and seals the design. The state then reviews it against its drinking water rules. Under TCEQ's general provisions, 30 TAC §290.39 (opens in a new tab), TCEQ will not consider plans and specifications unless a licensed professional engineer directed the work and sealed, signed and dated them. Specifications must accompany all plans, so a drawing-only package is not a complete Texas submittal.
TCEQ acts as a reviewing body only and does not examine structural features of the design. A tank foundation or a pump station slab rests with your engineer.
Not every waterline gets the same review. A new public water system needs TCEQ's written approval of its plans and specifications before construction. Under §290.39(j), a significant change to an existing system needs notice to TCEQ first, and distribution changes need plans when they exceed 10% of the connections, leave the system short of required capacity or interconnect with another public water system.
Is the lowest water system design quote the cheapest project?
Often not. The design fee is one line in the total. Construction, change orders, delay and decades of operation are the rest. Here is the whole equation:
Total project cost = design fee + construction cost + change orders + schedule impacts + long-term operating cost
A thin design moves work from the first term to the others. Here is how it can go. A developer picks the lighter of two design scopes. The high end of the subdivision cannot hold pressure, so a booster pump station goes in after the fact. Utility conflicts no one profiled stop the crew. Missing connection details send the design back in the middle of construction.
Together those costs can run far past what the lighter scope saved. Caught in a model and a profile set, each would have been a line on a redesign, not a field cost. If you are a developer or builder carrying land while the field sorts it out, schedule is part of the price.
Construction support is easy to leave out of a quote, but someone still does it. Section 290.39 requires the engineer or owner to watch construction closely enough to confirm it matches the approved plans, then tell TCEQ in writing at completion that the work substantially follows the plans and change orders on file. If the quote has no construction-phase services, ask who signs that letter.
How do you compare two water system design proposals?
Score both against the same list. Where one says yes and the other is silent, you have found the price gap.
- Does it include a hydraulic model with named pressure and fire flow cases?
- Does it list plan and profile sheets, tie-in details and service connections?
- Does it include specifications that name materials and standards?
- Does it include the state submittal, where your project needs one, and responses to review comments?
- Does a licensed engineer seal it after an internal review?
- Does it include construction-phase services, including the completion notice?
- Does it list what is excluded?
Treat a silent item as an exclusion and ask before you compare prices. Then ask both firms for a sample plan set from a similar water project, who will review the design and what water systems that engineer has designed, and how often their recent projects needed design-related change orders.
A note on limits: this is general education based on 30 TAC §290.39 and §290.44 as amended effective December 21, 2023. Other states, utilities and fire officials add their own criteria, and your engineer applies them to your site.
Frequently asked questions
What is included in a water system design quote?
It depends on the firm, which is the problem. A complete scope covers a hydraulic model, plan and profile sheets, specifications, the state submittal and construction-phase services. Get the list in writing.
Does a water system design need a PE seal in Texas?
Yes, for plans submitted to TCEQ for a public water system. TCEQ will not consider plans and specifications unless a licensed professional engineer directed the work and sealed, signed and dated them.
What should I ask before signing the cheaper of two water system proposals?
Ask both firms for a sheet list and a deliverables list, then run the checklist above. If the lower quote drops the model, the profiles, the specifications, the TCEQ submittal or construction support, find out who does that work before you decide.
Can a Texas water district just take the lowest engineering quote?
No. Under Texas Government Code Chapter 2254 (opens in a new tab), a district must first select the most highly qualified engineer on demonstrated competence and qualifications, then try to negotiate a fair and reasonable price (§2254.004). The Texas engineering board's guide to the Professional Services Procurement Act (opens in a new tab) says fees stay out of that first selection.
Related resources
- Public Water System Design and Implementation in Texas
- How to Conduct a Fire Flow Analysis for a Texas Development or Subdivision
- Why EPANET Is the First Choice for Water Network Modeling
- The Cheapest Engineering Decision on Your Texas Pro Forma Isn't the Low Bid
Comparing water system design proposals and not sure they quote the same job?
Send us both scopes. We will tell you plainly what each one includes and what it leaves for someone else to do. Talk with an engineer about your proposals.
