Blog
Erosion and Sedimentation Control at the Discharge Point: What Inspectors Check When Test Water Hits Open Ground
Erosion and sedimentation control at the discharge point is a TXG670000 condition, so here is what inspectors check when test water lands on open ground.
Quick answer
Clean test water can still fail at the discharge point. Erosion and sedimentation control at the discharge point is a written condition of TCEQ's hydrostatic test water general permit, not a courtesy. The water has to land on a splash pad, a paved area or another surface that will not erode, and the discharge rate has to be held down with best management practices.
Inspectors look at what the water does when it hits the ground: the surface it lands on, how fast it is coming out, where it runs, and whether the controls were in place before the first gallon left the pipe.
What does TCEQ's permit actually say about erosion?
Two sentences, and both are requirements. TPDES General Permit TXG670000, reissued effective April 5, 2025 and expiring April 5, 2030, covers hydrostatic test water discharged into or adjacent to water in the state. Part III, Section B.1 says the discharge shall be to a splash pad, a paved area or other alternative surface to prevent erosion, and that the rate of discharge shall be controlled through best management practices to prevent flooding and erosion.
That applies whether or not you filed a Notice of Intent. New vessels and vessels that held raw or potable water need no NOI under Part II, Section C.4, but only if the discharger complies with all applicable permit conditions. Erosion control is one of them.
Part III, Section B.11 adds that disposal must prevent nuisance conditions. Muddy water running across a street or into a neighbor's yard is the kind of condition that gets reported.
Why does clean water still cause an erosion finding?
Water quality and erosion are separate tests. A crew can dechlorinate properly, meet the total residual chlorine limit and pick a sensible location, then point an open hose at bare dirt. The water was fine. The ground was not.
Concentrated flow carries energy. Released at one spot onto unprotected soil, it cuts a channel, picks up sediment and carries it toward the nearest ditch, inlet or creek. What leaves the site is now turbid water, even though what left the pipe was clear.
What do inspectors check at the discharge point?
The landing surface first, then the path. A practical pre-discharge check looks like this. If any answer is no, fix it before opening the valve.

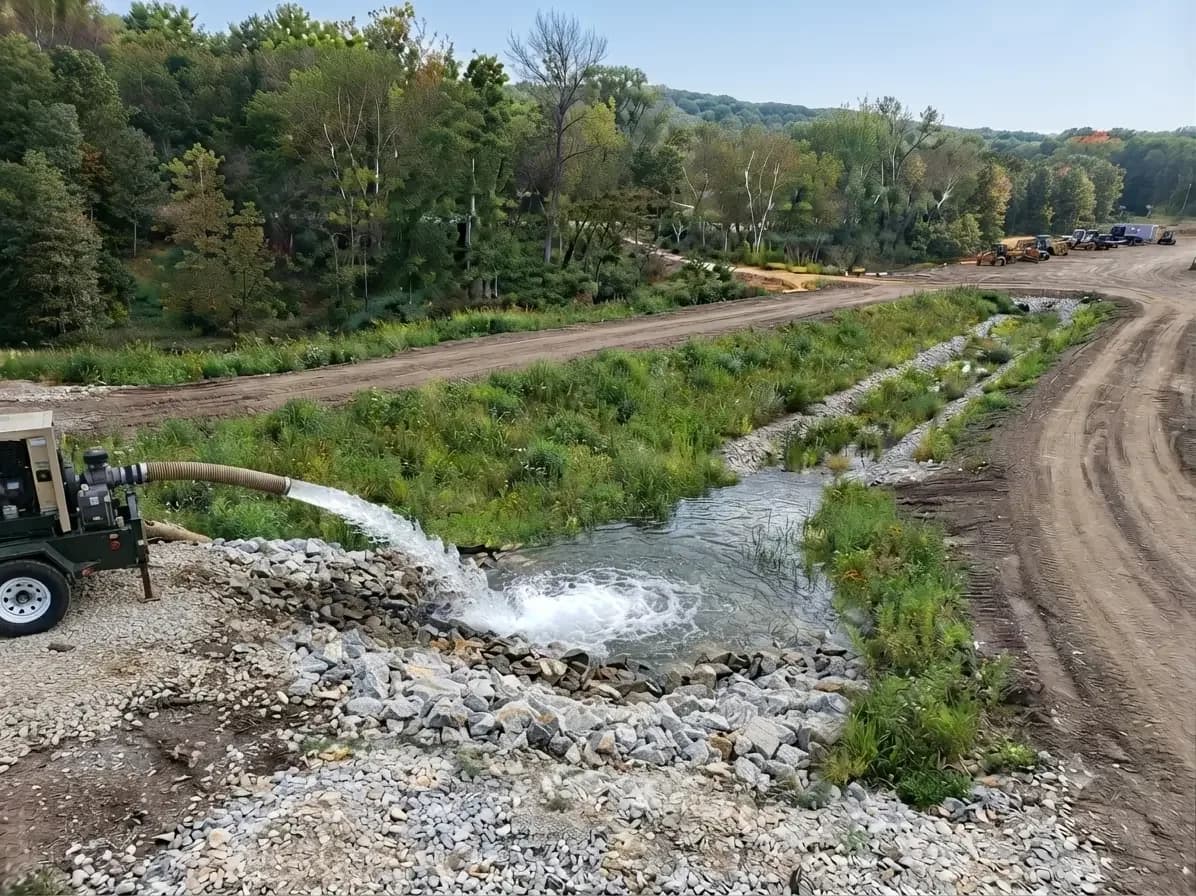

- Does the water land on a splash pad, paving, a rock pad or another surface that will not scour?
- Is the flow spread or slowed, with a diffuser, spreader or energy dissipater, rather than one concentrated jet?
- Can the valve throttle the rate, and does someone own that valve for the whole discharge?
- Has someone walked the flow path from the outlet to the first ditch, inlet or channel?
- Are sediment controls such as filter bags, check dams or a settling area in place where the path crosses bare ground?
- Were the controls installed before discharge began, with photos to show it?
The last item matters most. A rock pad placed after a gully has formed shows the planning gap rather than closing it.
Which controls fit which conditions?
Match the control to the energy and the ground. No single device fits every site, so the choice belongs in the discharge plan, not in the truck.
- Splash pads and riprap pads break up a jet at a fixed outlet. They are the baseline the permit names.
- Diffusers and spreader bars turn one point of flow into a wide sheet, which bare soil handles far better.
- Filter bags catch sediment the water picks up in the vessel or at the outlet.
- Check dams slow flow along a swale or ditch so sediment drops out before the outfall.
- Erosion blankets and existing vegetation protect the path beyond the pad, where a well-built outlet can still feed a bare slope.
Discharge volume, duration, slope and soil type drive the selection. A short flush from a small main and an all-day drain of a large tank are different problems.
What if the water is land applied instead of sent to a ditch?
Then the rules get stricter about runoff. Part III, Section C of the permit covers land application. It shall not occur when the ground is frozen, saturated or has standing water, during rainfall, or within 24 hours of a rain of 0.5 inch or more in 24 hours.
Land application shall not result in runoff or ponding, the permittee must maintain vegetation in the application area, and water may not be land applied within 500 feet of any water well. If your plan is to spread the water on open ground, the ground has to absorb it.
How does this overlap with the site's stormwater plan?
They are separate permits on the same ground. Many test discharges happen on active construction sites. TCEQ's construction stormwater general permit, TXR150000, requires operators of sites disturbing one acre or more to develop and implement a Stormwater Pollution Prevention Plan (SWP3) before construction starts.
The SWP3 covers stormwater. The test water discharge is still governed by TXG670000. In practice the same silt fence, inlet protection and stabilized areas often serve both, so the discharge location should be shown on the site's erosion control plan and checked against it. Our SWPPP and erosion and sediment control plan work treats the test discharge as one more flow the plan has to handle.
Why does turbidity get noticed first?
Because anyone can see it. Nobody needs a meter to notice brown water entering a clear creek or a storm inlet. A discharge that starts clear and turns turbid as it crosses bare soil shows erosion happening in real time.
That visible sign is often what turns a quiet discharge into a phone call. Controlling erosion at the outlet and along the path is the most direct way to keep the discharge looking like what it is: clean water.
Limits: this article summarizes TXG670000 and TCEQ's construction stormwater page as of October 2026 for general education. It does not cover discharges regulated by the Railroad Commission of Texas, the Edwards Aquifer rules or local ordinances, which can add requirements. Your engineer should confirm the controls for your site.
Frequently asked questions
Does a discharge with no NOI still need erosion controls?
Yes. The NOI exemption for new vessels and potable water vessels in Part II, Section C.4 applies only when the discharger complies with all applicable permit conditions, and the splash pad and rate control requirement in Part III, Section B.1 is one of them.
Is a paved area always acceptable?
The permit names a paved area as an acceptable surface. Check where the water goes next. Paving that drains straight to an inlet moves the question to the storm sewer, and an MS4 operator expects written notice at least 48 hours before discharge under Part III, Section B.14.
Can we add controls once we see erosion starting?
You should, and you should slow or stop the discharge while you do. Late controls limit damage but do not undo it, and an inspector will read them as a sign the discharge was not planned.
I'm a superintendent on a Texas subdivision and we're flushing a new 12-inch main next week across a lot that was just graded. What should I set up at the outlet?
Start with a stabilized landing surface such as a rock pad or a section of paving, then a diffuser or spreader to widen the flow. Walk the path to the first inlet or ditch, add filter bags or check dams where it crosses bare soil, and photograph everything before you open the valve. Throttle the valve if the path starts to cut.
We're a small utility in Texas planning to land apply test water from a storage tank on a pasture. What would make an inspector stop the discharge?
Runoff or ponding leaving the application area, applying on saturated ground or within 24 hours of a half-inch rain, bare ground in the application area, or a water well within 500 feet. Each is a stated condition in Part III, Section C of TXG670000.
