Blog

Discharging to a Storm Drain vs. Sanitary Sewer: Why Texas Contractors Get It Wrong on Pipeline and Tank Projects

Storm drain vs sanitary sewer: on a Texas pipeline or tank job, each system has a different owner and different rules, so confirm which one you have first.

Quick answer

A storm drain and a sanitary sewer are two separate systems with two separate owners and two separate sets of rules. Storm drain vs sanitary sewer is the first call on any pipeline or tank job: a storm drain carries water, untreated, to a creek, and a sanitary sewer carries it to a treatment plant.

Water sent to a storm drain ends up in a creek, so it must meet the hydrostatic test water permit's conditions and the city's stormwater rules. Water sent to a sanitary sewer needs the sewer utility's written yes. Confirm which system an opening connects to before anyone opens a valve.

Sanitary sewer manhole surcharging from excessive construction discharge volume exceeding collection system capacity.

Why do crews mix up storm drains and sanitary sewers?

Because the openings look alike and the closest one wins. A curb inlet, a manhole lid and a ditch all look like "the drain" to a crew that needs to empty a test section before dark.

The trouble is that the choice of opening is also the choice of regulator. One opening sends the water to a creek under state and city stormwater rules. The other sends it to a wastewater plant under the utility's sewer rules. Appearance and distance tell you nothing about which is which.

How do you tell which system an inlet or manhole connects to?

Check the drawings, then confirm with the owner. Start with the as-built utility drawings for the site and the utility's own maps. Where the record is unclear, ask the city or utility that owns the line to confirm it in writing.

Maps age, and older areas have had decades of repairs and additions, so the owner's confirmation is worth more than a reading of an old sheet. If the project is in an older core area, read up on combined and separate sewer systems in older Texas cities before you plan the discharge point.

What rules apply when test water goes to a storm drain?

A storm drain discharge is a discharge to a creek with a delay. Anything that goes in the inlet reaches the receiving stream with no treatment, so the water has to be clean enough for the stream.

In Texas, hydrostatic test water discharged to water in the state is covered by TCEQ's hydrostatic test water general permit, TXG670000, current through April 5, 2030. Three of its conditions bear directly on a storm drain discharge:

  • When the discharge starts inside a municipal separate storm sewer system (MS4), the permittee must notify the MS4 operator in writing at least 48 hours before starting (Part III, Section B.14).
  • When an NOI is required, a copy goes to the MS4 operator at the same time it goes to TCEQ (Part II, Section C.2.c).
  • Hyperchlorinated water must meet a total residual chlorine limit of 0.10 mg/L, sampled before it mixes with stormwater (Part III, Section A.1).

The city has its own say. Under the federal small MS4 rule, 40 CFR 122.34(b)(3), MS4 operators must prohibit non-stormwater discharges by ordinance. Water line flushing and potable water discharges are on the list the operator may allow unless it finds them a significant source of pollutants. So the answer depends on the city's ordinance, not on what the last city allowed. Smaller cities' obligations are covered in our post on Phase II MS4 permits.

What rules apply when test water goes to a sanitary sewer?

The sewer owner decides, and TCEQ's general permit steps aside. TCEQ's TXG670000 fact sheet lists discharge to a publicly owned treatment works (POTW) as a disposal method that needs neither the general permit nor an individual wastewater permit (Section III.3.c).

That does not make the sewer an open door. The federal pretreatment rule, 40 CFR 403.5, bars anything that causes pass through or interference at the plant. It names specific prohibitions that matter for test water:

  • solids in amounts that obstruct flow (403.5(b)(3));
  • a flow rate or concentration that causes interference (403.5(b)(4));
  • trucked or hauled water, except at discharge points the POTW designates (403.5(b)(8)).

Under 403.5(c), POTWs set local limits to carry out these prohibitions. In practice, the city's sewer use ordinance and the utility's approval letter set the rate, the hours, the volume and any testing before release. Industrial users already live with this; see Texas pretreatment permits for facilities discharging to a POTW.

Is the sanitary sewer always the safer choice?

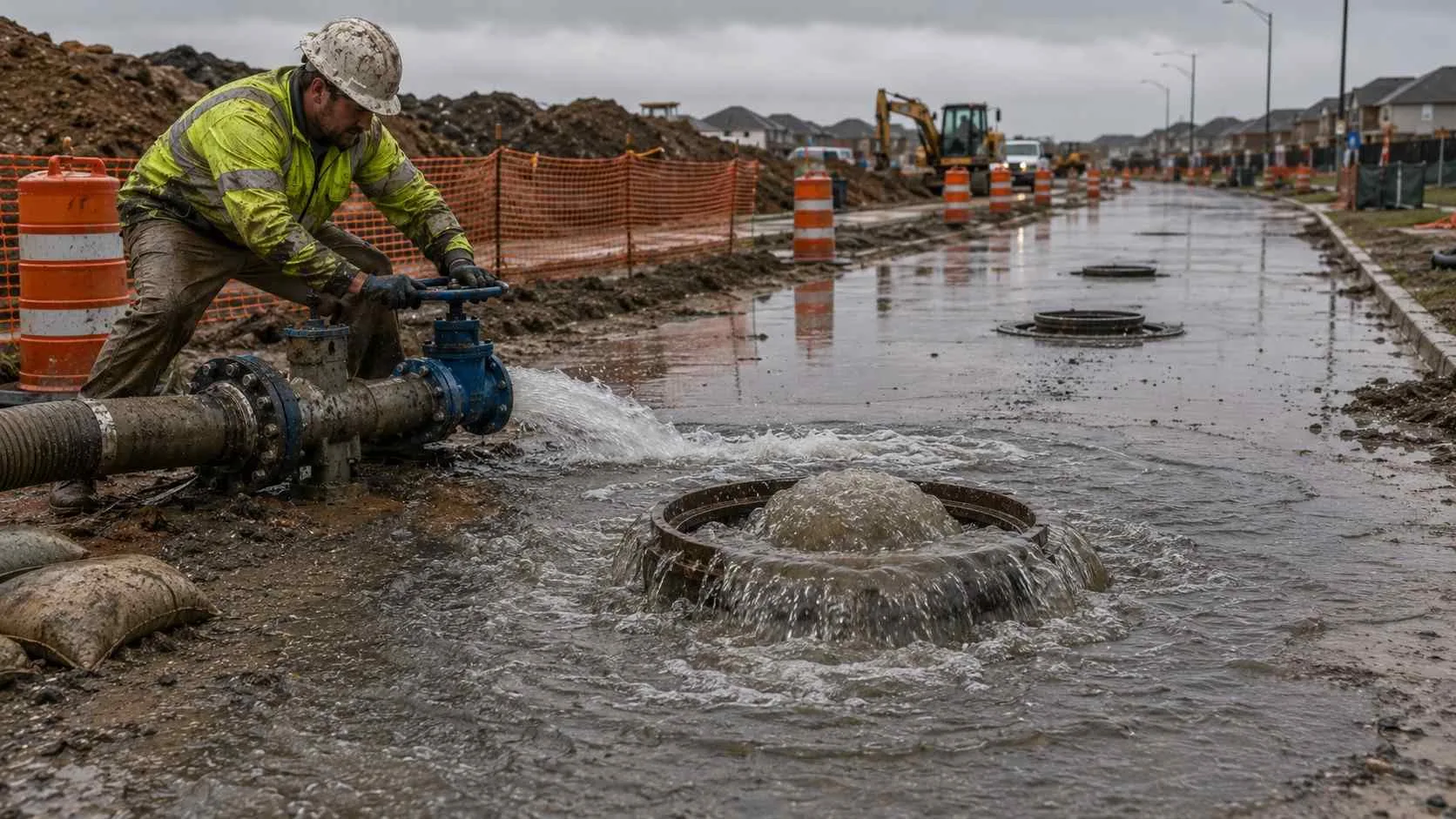

No. It trades a water quality risk for a capacity risk. A large release into a small sewer segment can surcharge the line and back up upstream. If that flow leaves the system at a manhole, you have created a sanitary sewer overflow, which is a worse problem than the one you were avoiding.

Sediment is the other sewer concern. Pipe cuttings and sand that a creek would carry away can settle in a sewer line that was never meant to move grit. Ask the utility what it wants removed before the water goes in.

Does the water quality check change with the system?

The same tests apply, but they carry different weight. Residual chlorine is the big issue for a storm drain, because it goes straight to aquatic life. In a sewer, the water mixes with wastewater before it reaches the plant, though dose and volume still matter to the utility.

Rate matters to both, for different reasons. At a storm drain outfall, a fast release causes scour and erosion downstream. In a sewer, it causes surcharging. Measure residual chlorine, pH and solids on every release, and set the rate for the system that actually receives the water.

What happens when water goes into the wrong system?

The fix costs more than the phone call would have. Under TXG670000, Part III, Section B.12, noncompliance that may endanger health or the environment must be reported to the TCEQ regional office within 24 hours, with a written report within five working days.

On the sewer side, the utility can enforce its own ordinance. On both sides, TXG670000 grants no right to use private or public property along the discharge route (its cover page and Part IV.11). Get each owner's permission in writing and keep it with the field log.

Limits of this article: this is general education on Texas and federal rules as of October 2026, not advice for a specific site. City ordinances and utility terms vary, so confirm the path with the system owner and, where a discharge may not fit the general permit, with TCEQ.

Frequently asked questions

Can I discharge hydrostatic test water to a storm drain in Texas?

Often, yes, if the discharge meets TXG670000's conditions, the MS4 operator gets 48 hours' written notice, and the city's ordinance allows it. Hyperchlorinated water must be dechlorinated to the 0.10 mg/L limit first.

Do I need a TCEQ permit to send test water to the sanitary sewer?

TCEQ's fact sheet says discharge to a POTW needs neither the general permit nor an individual permit. You still need the sewer utility's approval, on its terms.

Does one approval cover both systems?

No. The storm drain and the sanitary sewer usually have different owners, or different departments in the same city, each with its own approval.

I'm a contractor testing a new force main in a North Texas city, and the nearest opening is a manhole in the street. How do I confirm it is sanitary and not storm before we discharge?

Pull the as-built drawings and the utility's maps, then ask the line's owner to confirm in writing. If it is sanitary, ask the same utility for its acceptance terms. Do not rely on the lid or the location.

I'm a site superintendent with a tank test and a curb inlet right next to the pad. If the water is potable and dechlorinated, do I still have to tell anyone before I discharge?

Yes. If the discharge starts inside an MS4, TXG670000 requires written notice to the MS4 operator at least 48 hours ahead, and written notice to the TCEQ regional office at least 48 hours ahead (Part III, Section B.13). The city may have its own requirements too.
