FDEP Permitting for Wastewater Systems in Florida: A Practical Guide for Developers
FDEP wastewater permitting in Florida covers sewer extensions, lift stations and private plants. See what each permit requires before you close on land.
FDEP wastewater permitting covers nearly every part of a Florida development's wastewater system: gravity sewers, lift stations, force mains and any treatment plant you build, and you need the authorization before construction. The bigger risks are plant capacity, effluent disposal and the other agencies. Settle those before you close on the land.
What triggers FDEP wastewater permitting in Florida?
Building, expanding or changing anything that collects, transmits, treats, reuses or disposes of domestic wastewater.
FDEP's wastewater permitting page says anyone doing those things generally needs a wastewater permit, issued mostly by its six district offices or a delegated local program. For a development:
- Sewer, lift stations and force mains fall under Chapter 62-604, F.A.C., Collection Systems and Transmission Facilities, private systems included.
- A treatment plant usually needs an individual permit under Chapter 62-620, F.A.C., which covers both construction and operation.
- Reuse and land application follow Chapter 62-610, F.A.C.
- A surface water discharge needs an NPDES permit, which FDEP has issued since EPA authorized it in 1995.
Changes count too. Under Rule 62-620.300, F.A.C., a facility that stays in service during a modification needs a permit revision first.

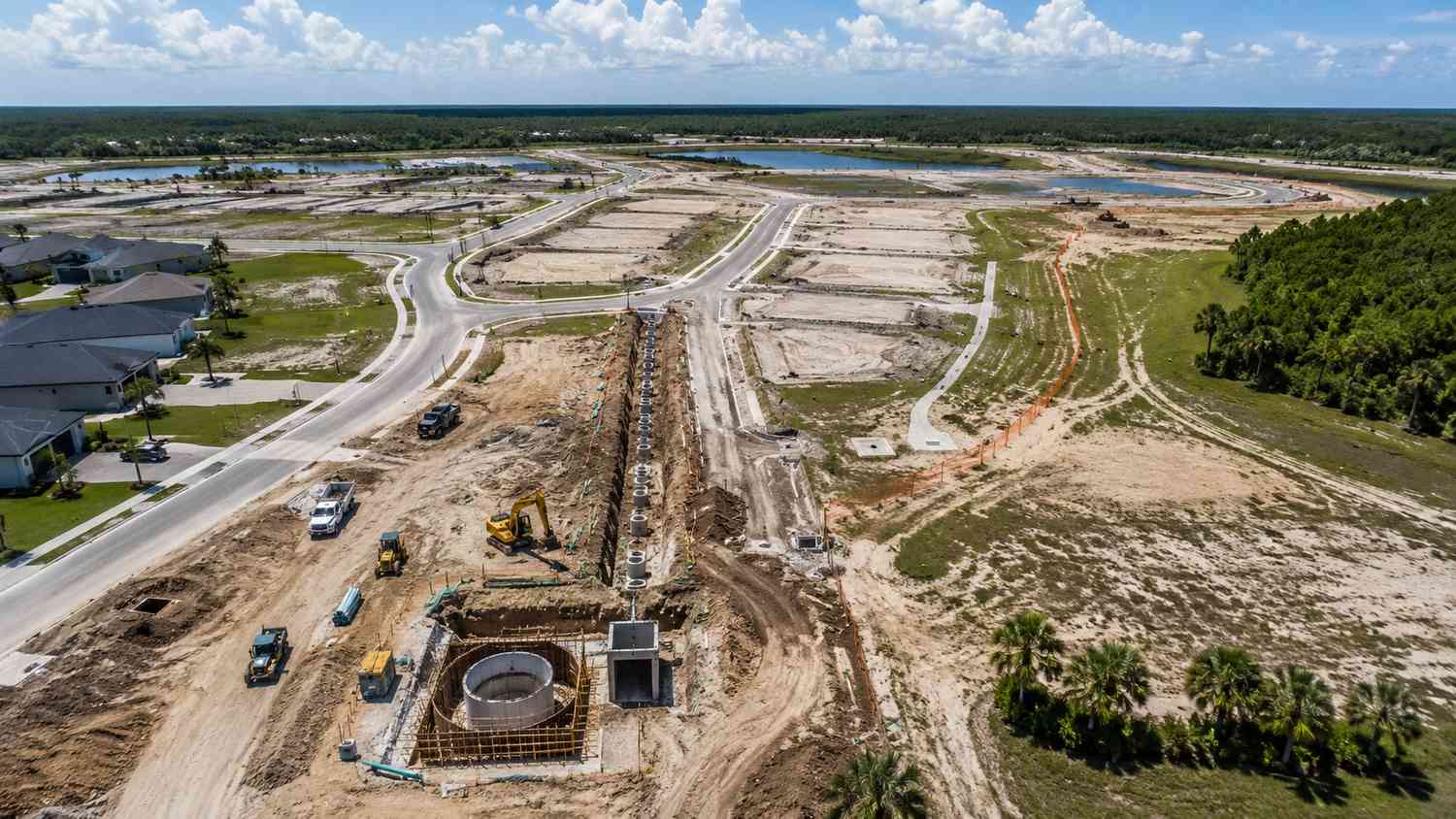

How do you permit a sewer extension in Florida?
A conventional extension can go under a general permit: file a notice at least 30 days before construction, and confirm the receiving plant has room.
Rule 62-604.600, F.A.C. grants the general permit in subsection (6) for conventional gravity sewers, pump stations and force mains. The notice goes on DEP Form 62-604.300(3)(a). To qualify, the receiving facility must have capacity for your flow and comply with the capacity analysis rule, Rule 62-600.405. Otherwise you apply for an individual permit on the same form.
When the work is done, Rule 62-604.700, F.A.C. requires Form 62-604.300(3)(b), Notification of Completion of Construction, before the system starts operating. It can start 3 days after FDEP receives the form, or 10 days if substantial deviations are noted.

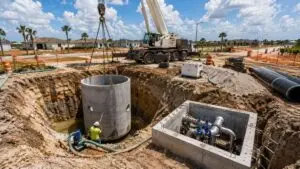

What does FDEP require at a lift station?
Emergency pumping at every station, an in-place generator at the larger ones, and a station that works through a 25-year flood.

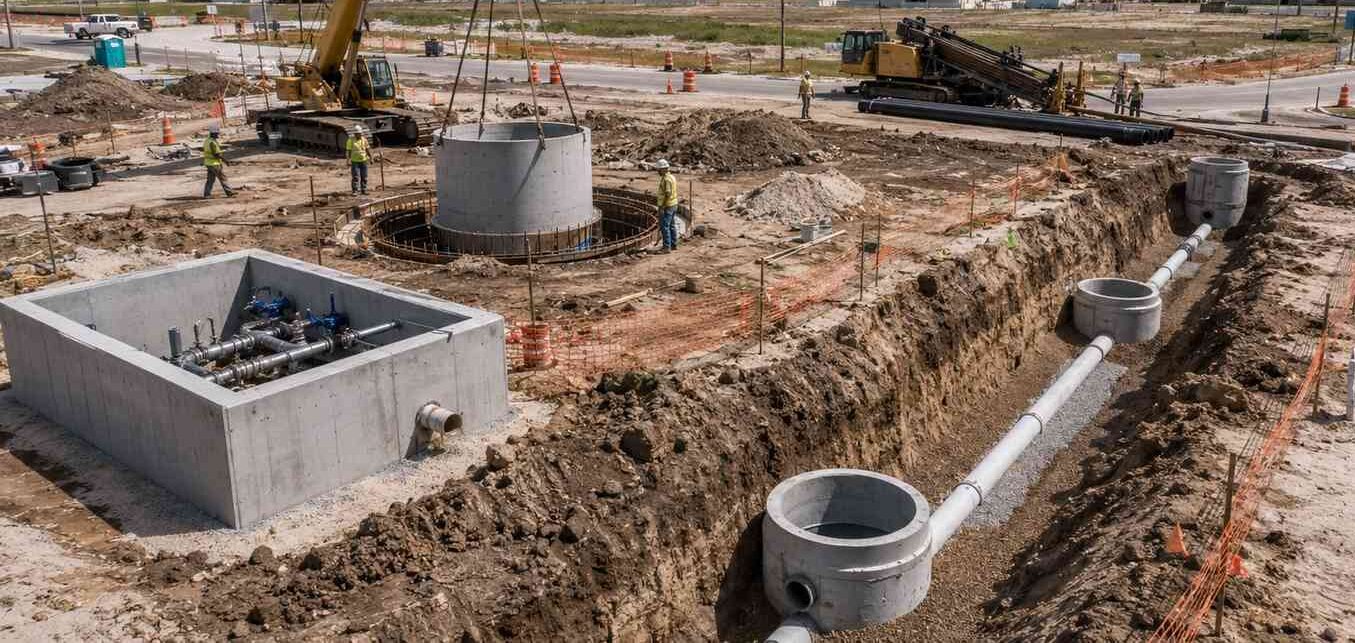

Rule 62-604.400, F.A.C. sets the collection system design rules:
- A station that receives flow from other stations through a force main, or discharges through pipes 12 inches or larger, needs an in-place emergency generator, (2)(a)1.
- Other stations can use two independent utility substations, a generator connection or portable pumps, (2)(a)2.
- Every station gets a force main riser with rapid-connect fittings for a portable pump, (2)(a)3.
- Equipment is protected from the 100-year flood, and the station stays operational in the 25-year flood (local conditions can justify less, never below the 10-year), (2)(e).
- New systems sit at least 100 feet from a public drinking water supply well and 75 feet from a private one, absent an approved alternative, (1)(c).
Flat ground means more lift stations and longer force mains. EPA's CMOM guide for collection systems lists long detention times, pump stations and force main discharge points among the places hydrogen sulfide forms. Our post on force main corrosion in Florida's coastal environment covers the design choices.
How do you confirm treatment capacity and utility service availability?
Get a written capacity commitment from the utility, and ask for the receiving plant's latest capacity analysis report.
Under Rule 62-600.405, F.A.C., a plant whose three-month average daily flow passes 50% of permitted capacity files that report, then updates it. If capacity will be reached within 5 years, an engineer seals a statement that planning has started. Within 4 years, plans and specifications must be underway. Within 3 years, a complete expansion permit application is due within 30 days of the report.
A plant inside 3 years with no expansion application on file is a schedule risk for every new connection. Answer this in the site feasibility study, before your earnest money goes hard.

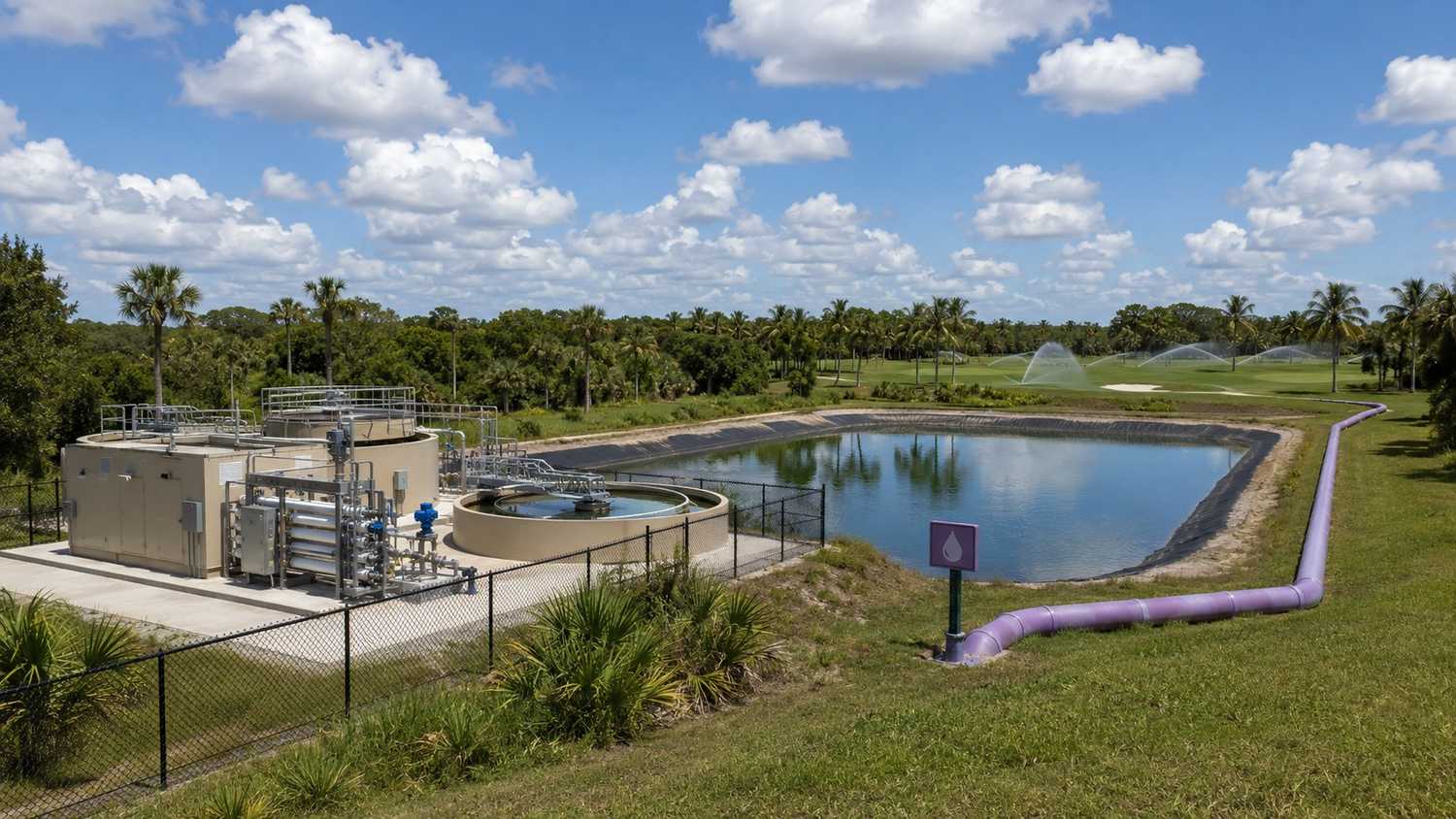

What does FDEP permitting require for a private wastewater treatment facility?
Usually an individual permit under Chapter 62-620, built on a preliminary design report sealed by a Florida professional engineer.
The application uses Form 1 and Form 2A from Rule 62-620.910, F.A.C. FDEP's preliminary design report guidelines, drawn from a 2001 permitting guide, ask for flow projections, a site plan with 100-year and 25-year flood elevations, odor, noise and aerosol drift effects, the reuse or disposal method, reliability features and residuals handling.
For developers and builders, the plant, its buffers and the effluent areas belong on the land plan from the first concept.
Why does Florida push reuse over surface water discharge?
State law makes reuse a state objective, sets a 2032 deadline to end nonbeneficial surface water discharges, and requires advanced treatment for discharges to sensitive waters.
Section 403.064, F.S. calls reuse of reclaimed water a state objective. Subsection (16) had surface water dischargers plan to eliminate nonbeneficial discharge by January 1, 2032, with exemptions for some small and rural systems.
Section 403.086, F.S. bars discharges without advanced waste treatment into Tampa Bay, Biscayne Bay and other listed waters, adds the Indian River Lagoon from July 1, 2025, and by January 1, 2033, reaches nutrient-impaired waters and waters under a nutrient basin management action plan. Advanced waste treatment means 5 mg/L CBOD5, 5 mg/L suspended solids, 3 mg/L total nitrogen and 1 mg/L total phosphorus on an annual average, plus high-level disinfection.
Reuse on lawns, golf courses and parks is public access reuse. Rule 62-610.460, F.A.C. requires secondary treatment, filtration and high-level disinfection for it. The catch for small plants is Rule 62-610.451, F.A.C.: a plant designed for under 0.1 mgd cannot supply public access reuse, except for toilet flushing or fire protection.
Which environmental and local permits need coordinating with FDEP?
Usually an Environmental Resource Permit and local utility agreements, and sometimes septic permits.
FDEP's Environmental Resource Permit program covers work that alters surface water flows, including construction stormwater and filling wetlands. FDEP or one of five water management districts processes it, depending on the activity. For septic, FDEP's onsite sewage permitting FAQ says DEP now issues permits in Northwest Florida and Marion County, and county health departments still issue them elsewhere.
Ask for a pre-application meeting. FDEP's Southeast District, for one, holds them on request.
How long does FDEP take to act on a wastewater permit?
The rules set the agency's clock, not your project's: 30 days to flag gaps, then 90 days from a complete application to a decision.
For a treatment plant, Rule 62-620.510, F.A.C. sets it, and the decision is on a draft permit that then goes to public notice. Each round of questions moves the start line, so a complete first package is your best schedule tool.
Is your Florida site ready for FDEP wastewater permitting?
Six yeses mean it is ready for permit design.
- Do you have a written capacity commitment from the utility?
- Have you read the receiving plant's latest capacity analysis report?
- Do you know which lift stations need an in-place generator?
- If you need a plant, have you picked the effluent path?
- If reclaimed water will irrigate common areas, is the plant designed for at least 0.1 mgd?
- Have you mapped the ERP, utility and county approvals next to the FDEP permit?
Any no is the next thing to settle.
Ask your engineer: Which plant takes our flow? Does our receiving water trigger advanced waste treatment?
A note on limits: this is general education from Florida statutes and FDEP rules and guidance as of October 2026. FDEP held a March 2026 rulemaking workshop on Chapters 62-600, 62-620 and 62-699, so check current rule text. Your permit governs, and no article can predict a review outcome or schedule.
Frequently asked questions
Does FDEP issue NPDES permits in Florida?
Yes. FDEP has run the NPDES program since 1995, and surface water discharges are not delegated to local programs.
Do I need an FDEP permit to extend a sewer line?
Yes, from FDEP or a delegated local program, before construction. A conventional extension can use the general permit with a 30-day notice, if the receiving plant has capacity.
Who permits septic systems in Florida now?
DEP in Northwest Florida and Marion County; county health departments everywhere else, pending legislative approval of the rest of the transfer.
I'm developing a 200-lot subdivision in Central Florida and the county utility says capacity is tight. What should I ask for before I close on the land?
A written capacity commitment for your flow, with its conditions and expiration, and the plant's latest capacity analysis report. If later phases depend on an expansion nobody has applied for yet, build that delay into the purchase terms.
I'm a civil engineer in Florida designing a small package plant for a community with no sewer. Can the reclaimed water irrigate the lawns and common areas?
Only if the whole plant's permitted capacity is at least 0.1 mgd. Below that, look at slow-rate restricted access land application, which FDEP says may qualify for a generic permit, or another disposal method.
Related resources
- Water Reuse in Florida: How the State’s Progressive Rules Are Shaping Infrastructure Design
- Florida’s Advanced Wastewater Treatment Mandate: What AWT Requirements Near Impaired Waters and Springs Add to a Project’s Treatment Design
- Lift Station Design for Florida’s Flat Topography: Challenges Every Developer Should Understand
- Florida’s Exploding Growth vs. Aging Wastewater Infrastructure: What Engineers Are Facing Right Now
Planning a wastewater system for a Florida development?
We check utility capacity, effluent options and lift station needs before you commit to a site, then design the system around what FDEP reviews.
Modern Engineering Solutions is licensed in Florida. Talk to us about your site, or call (214) 833-6748.
Keep reading
More to read.
Talk to an engineer
Tell us about your project.
An engineer reads it
Not a salesperson. Someone who can tell you whether the pathway is real.
You get a first answer
Your options, the agencies involved and the questions that decide cost and schedule.
You decide
No commitment to have the first call.
Prefer the phone? (214) 833-6748
