Local Sewer Connection vs. State Permit: When a California SIU Permit Is the Faster Path

A local sewer connection under a California SIU permit is often the faster path because it skips the state filing, but only when the POTW can take your flow.

Quick answer

A local sewer connection under an SIU permit is often the faster path for a California industrial facility, because it takes the state permit off your critical path. A discharge into a community sewer needs no Report of Waste Discharge to the Regional Water Board. Your review sits with the local POTW instead.

That only holds when the POTW has capacity, will accept your waste stream, and your discharge can meet its limits with pretreatment you can build in time. Check those three before you count on it.

What are the three discharge paths, and how do you know which one you are on?

The destination of the water decides the path, not your preference. A California industrial facility generally sends process wastewater to one of three places:

  • Surface water: a direct discharge to a stream, river or other surface water needs an NPDES permit, which in California the Water Boards issue, usually through the Regional Water Board.
  • Land or groundwater: a discharge to land, such as land application or percolation, needs waste discharge requirements (WDRs) from the Regional Water Board under the Porter-Cologne Water Quality Control Act.
  • A community sewer: the POTW treats your water and discharges it under its own permit. Your discharge is governed by the POTW's pretreatment program and, if you qualify as a significant industrial user, by an individual SIU permit.

These are three different regulatory questions, not three speeds of the same one.

Why does the sewer path skip the state filing?

Because the Water Code carves sewer discharges out of the state report requirement. Water Code section 13260 requires anyone discharging waste that could affect the quality of the waters of the state to file a report with the Regional Water Board, "other than into a community sewer system."

The state paths come with filing lead times you cannot skip:

  • WDRs: Water Code section 13264 bars a new discharge until WDRs are issued, a waiver is granted, or a conditional 140 days pass after a complete report. Our post on the 120-day WDR rule in California sorts out the numbers boards quote.
  • NPDES: under 40 CFR 122.21(c)(1), anyone proposing a new discharge must apply at least 180 days before it starts, unless the permitting authority allows a later date.

Those are minimum filing dates, not approval times. The sewer path replaces them with the POTW's own review, which runs on the POTW's schedule.

When does the sewer path stop being faster?

When the POTW cannot or will not take the water as you plan to send it. Four conditions usually decide it:

  1. Capacity. The collection system and the treatment plant both need room for your flow. Where either is near its limit, the POTW may need upgrades, charge capacity fees, or decline new industrial flow until they are built.
  2. Acceptance. Some POTWs will not take certain waste streams at all, however well you pretreat. That pushes you to a state path whatever its timeline.
  3. Limits. Your discharge has to meet the POTW's local limits and any federal categorical standard. A large gap can mean a pretreatment system that takes longer to design and build than a state permit takes to issue.
  4. Distance. A sewer that exists somewhere nearby is not a connection. A long main extension adds its own easements, design and construction.

Confirm capacity and acceptance with the POTW in writing. A nearby manhole is not a capacity letter.

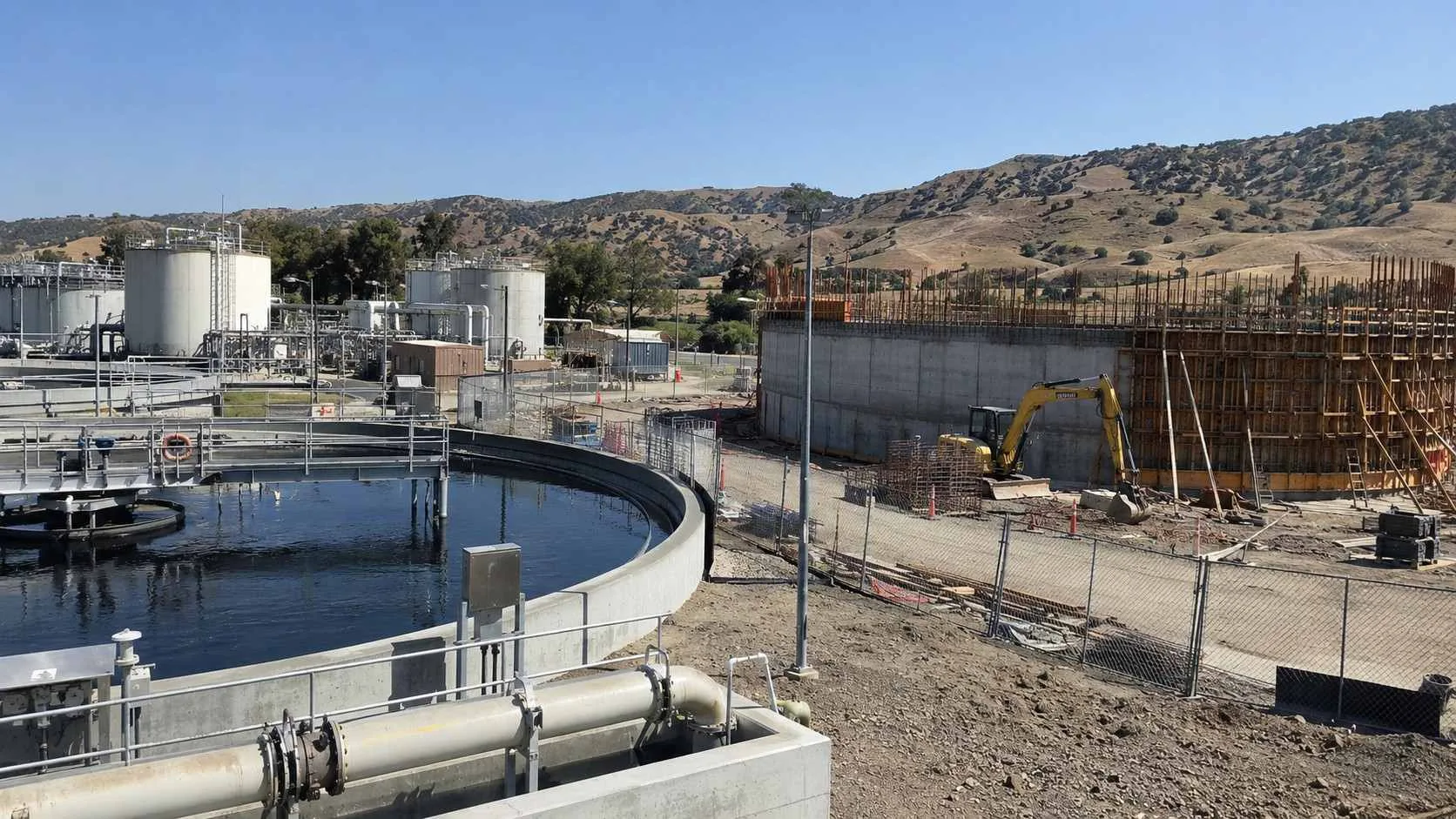

POTW treatment plant capacity expansion under construction

What does the sewer path still require?

It swaps state requirements for local ones; it does not remove them. The POTW, as control authority under its approved pretreatment program, will typically want an industrial user questionnaire, characterization data and, for an SIU, an individual permit before discharge.

An SIU carries ongoing monitoring, reporting and inspection access. A new source subject to a categorical standard also files a baseline monitoring report at least 90 days before discharge. Many POTWs charge sewer service surcharges on flow or pollutant loads above domestic strength, so build those into the operating budget, not just the permit plan.

Our post on California industrial discharge permits lays out the POTW's approval sequence step by step.

How should you compare the paths for a specific site?

Compare total schedule and total cost, not permit review alone. For each path, put on one sheet:

  • the permit filings and their legal lead times;
  • the treatment you must build, onsite or as pretreatment;
  • the infrastructure: sewer extension, outfall, or land disposal area;
  • ongoing obligations: monitoring, reporting, surcharges and operations.

With real sewer capacity and a waste stream the POTW accepts, the sewer path usually wins. Without them, a WDR or NPDES path can be the one that actually gets you to startup. Do the comparison before you commit to a site or a production date.

Limits of this article: it covers California's state paths and the federal pretreatment framework as of October 2026. Regional Water Boards and POTWs set their own forms, fees and practices. Confirm the path with the agencies before you rely on it.

Frequently asked questions

Does discharging to a sewer need a permit from the Regional Water Board?

Generally no. Water Code section 13260 excludes discharges into a community sewer system from the report requirement. The POTW regulates your discharge through its pretreatment program and, for an SIU, an individual permit.

How long before discharge must I apply for a new NPDES permit?

At least 180 days before the discharge begins under 40 CFR 122.21(c)(1), unless the permitting authority allows a later date. That is a filing deadline, not a promise of when the permit issues.

I'm siting a beverage plant in California, and the city sewer is close but the POTW is near capacity. Should we plan on the sewer or a state permit?

Get the POTW's written answer on capacity and acceptance first. If it needs upgrades before it can take your flow, price and schedule that against a WDR or NPDES path, including the treatment each one needs. Pick the path with the shortest total schedule, not the shortest permit.

I'm a developer with an industrial tenant that wants to discharge to land on our California site. Does that avoid the POTW entirely?

It avoids the POTW, but it brings in the Regional Water Board. A discharge to land needs a Report of Waste Discharge and WDRs or a waiver, along with the site's soil and groundwater review.

Does pretreatment go away if the POTW treats our water?

No. If your untreated wastewater would exceed a local limit or a categorical standard, you pretreat before the sewer, even though final treatment happens at the plant.
