Blog

The Six Month Rule: What California’s NPDES Timeline Actually Says and What It Does Not

The California NPDES timeline sets two 180-day filing deadlines, one for new dischargers and one for renewals, and neither one says how long review takes.

Quick answer

The "six months" in California's NPDES timeline is a filing lead time, not a review time. Under the federal rule California follows, 40 CFR 122.21, a new discharger must apply at least 180 days before the discharge begins, and a permit holder must reapply 180 days before its permit expires.

Neither rule says how long the Regional Water Board will take to issue the permit. Treat 180 days as the latest safe filing date, and build the real schedule from your receiving water and your application.

Where does the six-month figure come from?

From the federal NPDES application rule, which the Regional Water Boards apply in California. California runs the NPDES program under Chapter 5.5 of the Water Code, with the nine Regional Boards writing and adopting most individual permits. The application timing comes from 40 CFR 122.21:

  • New discharges, paragraph (c)(1): apply at least 180 days before the date the discharge is to start, unless the permitting authority allows a later date.
  • Publicly owned treatment works renewals, paragraph (d)(1): submit a new application at least 180 days before the existing permit expires.
  • Other renewals, paragraph (d)(2): submit a new application 180 days before the existing permit expires.

A later renewal date can be allowed, but never one after the permit expires. Some stormwater discharges have shorter lead times, and general permits set their own filing dates.

What does the rule protect for an existing permit holder?

Continuous coverage. Under 23 CCR section 2235.4, the terms of an expired NPDES permit continue automatically until a new permit is issued, if the federal continuation rules are met. The main federal condition is a timely, complete application.

File late and you risk a lapse, which means discharging without a permit. That is the whole job of the renewal deadline: keep an already-reviewed discharge covered while the Board does its work.

What does the rule mean for a new discharger?

It sets the minimum lead time, and nothing more. A new plant or outfall has to be in front of the Regional Board at least 180 days before the first discharge. The rule assumes the Board can finish in that window. It does not promise it.

A new discharge also has no prior permit to build on. Effluent limits, receiving water analysis and antidegradation review all start from scratch, so a new application usually carries more technical questions than a renewal does.

The practical rule: 180 days is the latest date to file, not the date to plan around. Work backward from startup with real margin, and file as soon as the design basis is firm.

What actually sets the review time?

The receiving water, the completeness of the application, and the public process. The main drivers are:

  • Effluent limits. The Board sets limits that protect the water quality objectives in its Basin Plan. A water body on the state's impaired waters list for a pollutant you discharge draws a harder review.
  • Antidegradation. Where a new or increased discharge would lower high-quality water, State Water Board Resolution 68-16 requires the Board to find the change is consistent with the maximum benefit to the people of the state, with best practicable treatment or control. For surface waters, the federal rule at 40 CFR 131.12 adds that the lower quality must be necessary for important economic or social development in the area.
  • Public notice. A draft NPDES permit goes out for public comment for at least 30 days under 40 CFR 124.10. Individual permits are often adopted at a Regional Board meeting, so the Board's calendar matters too.
  • Comments. A substantive comment on limits or antidegradation can require a written response or a revised draft.

Does CEQA hold up an NPDES permit?

Usually not the permit itself. Under Water Code section 13389, as applied in 23 CCR section 3733, the boards do not have to comply with CEQA before adopting WDRs that serve as an NPDES permit. The exception is a new source as the federal rules define it in 40 CFR 122.2 and 122.29, a category tied to industrial new source performance standards.

That does not take CEQA off your project. The land use approvals still need CEQA review by the lead agency, and so does a public agency's decision to build or fund the plant. WDRs for a discharge to land are not NPDES permits and do not get this exemption.

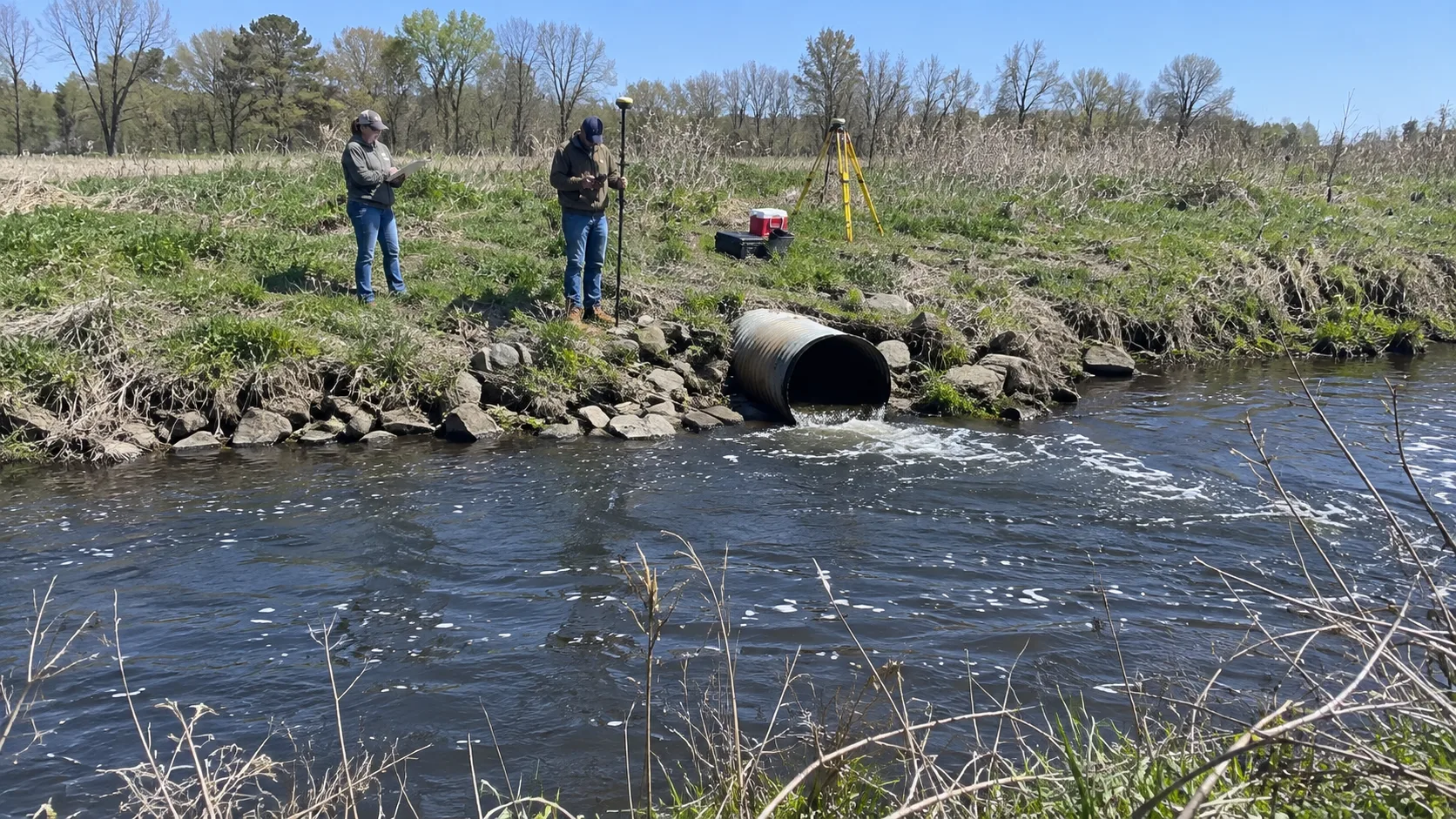

Surveying the exact discharge location at a creek bank

Which application gaps add review cycles?

The ones the Board cannot evaluate as submitted. Each gap usually means a request for more information and another round of review:

  • Flow projections without a clear basis, such as unit counts, phasing and a documented per-unit rate.
  • A discharge point described too loosely to model, without coordinates or the receiving water segment.
  • Estimated effluent quality that does not match the treatment process described.
  • No monitoring approach for the pollutants the Board is likely to limit.
  • No discussion of alternatives, such as reuse or a sewer connection, where antidegradation review will ask why a new discharge is needed.

The alternatives point is the one teams miss most. If the receiving water is high quality, expect the Board to ask whether the discharge is needed at all. Answering in the first submittal saves a round.

How should you build a realistic schedule?

Start from startup and work backward, with the filing deadline as a floor.

  1. Fix the design flow and phasing, with the basis written down.
  2. Pin the discharge point and identify the receiving water and its listed impairments.
  3. Meet Regional Board staff before filing to confirm the limits approach and antidegradation questions.
  4. Write the alternatives analysis, including reuse and sewer options.
  5. File complete, well ahead of the 180-day minimum.
  6. Track the public notice and the Board meeting calendar, and run project CEQA in parallel.

If your project could connect to a sewer instead, compare that path first. Our post on a local sewer connection versus a state permit walks through it.

Limits of this article: this is general education on the federal and California rules as of October 2026. Review time is set by the Regional Board for each permit, and nothing here predicts it. Confirm filing dates with the Board for your discharge.

Frequently asked questions

Is the 180 days a deadline for the Board to act?

No. It is a deadline for the applicant to file. Nothing in 40 CFR 122.21 requires the Board to issue a permit within 180 days.

Can we start discharging if the Board has not acted after 180 days?

No. A new discharge needs an issued permit before it starts. Only an existing permit holder that reapplied on time keeps coverage past expiration, under the continuation rule.

Can construction start before the NPDES permit is issued?

Construction that does not discharge can usually proceed on its own approvals. The discharge itself cannot begin until the permit is issued, so do not schedule startup ahead of it.

Is the 120-day WDR rule the same thing?

No. That rule concerns WDRs, which cover discharges to land and other waters of the state outside NPDES. Our post on the 120-day WDR rule explains it.

I'm building a new wastewater plant for a development in the Central Coast region, and my lender's schedule assumes the NPDES permit six months after we file. Is that safe?

Not on its own. Six months is the minimum filing lead time, not a review estimate. Ask Regional Board staff about the receiving water, the likely limits and the meeting calendar, then set the schedule with margin and file early.
