Blog

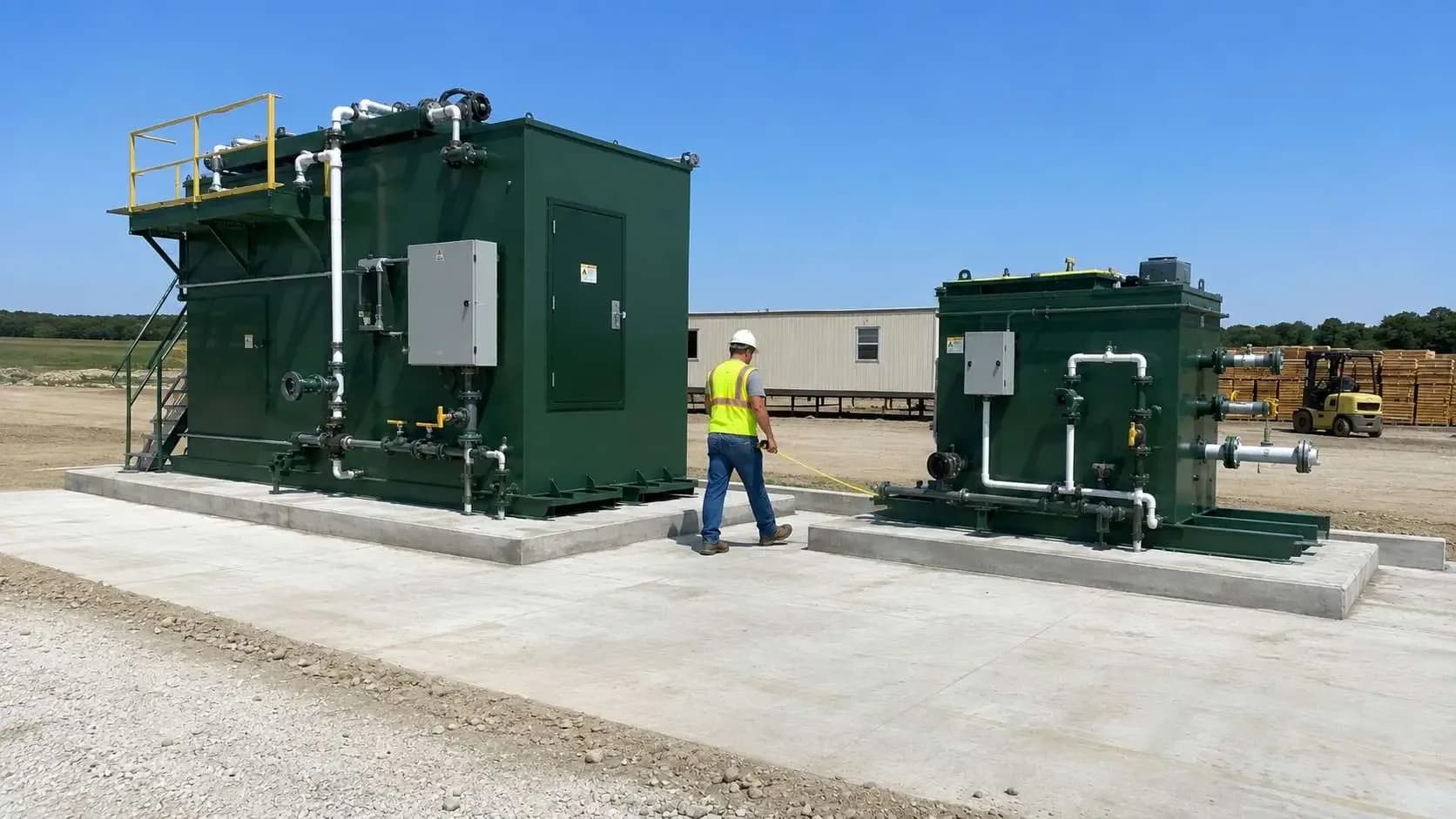

Decentralized Wastewater Clusters: Designing Multiple Small Package Plants Across a Phased Development

Decentralized wastewater clusters of small package plants can suit a phased Texas development, but each plant adds its own TCEQ review, buffer and operators.

Quick answer

Decentralized wastewater clusters put several small package plants near the phases they serve instead of one central plant. A cluster fits large sites, uncertain build-out, hard topography and regional sewer that is years away. But each plant brings its own TCEQ review, siting buffer, backup power, operator coverage and reporting, so weigh those before you commit.

When is one central plant still the right default?

When the development's extent and schedule are known, the sewer routes to one site are direct and the capital is there. One plant means one permit, one operator team and one monitoring program.

Phasing alone does not require a cluster. Under TCEQ's construction rule, 30 TAC §217.11, a plant is built in the phases its permit sets, with plans approval for each phase before it is built or operated. One site can grow in steps.

A cluster earns its place when the site itself works against a single plant.

What site conditions favor a cluster?

Distance, topography, timing and an outside sewer that is not there yet. The usual triggers:

  • Large acreage, where the sewers, lift stations and force mains to one plant cost more than the plants they would replace.
  • Topography that splits the site into separate drainage areas, so each plant can sit near a natural low point.
  • Uncertain build-out, where central capacity built now could sit idle for years.
  • A regional utility extension that is years out, so early phases need interim service.
  • Limited up-front capital, where treatment spending has to track lot sales.

Shorter runs do not remove the collection system. Each plant still needs its own sewers, and some will still need pumping. Our post on lift stations and collection systems covers those rules.

How does TCEQ look at more than one plant?

Expect each separately sited plant to need its own authorization, and each application to face a regionalization review. TCEQ's regionalization policy points to Texas Water Code §26.0282, which lets TCEQ deny or alter a discharge permit based on need and the availability of regional systems.

Applicants check for permitted domestic plants and collection systems within three miles. If one has capacity, the applicant contacts it and submits the correspondence and an analysis of what connecting would cost.

TCEQ says a nearby system is not an automatic basis to deny an application or force a connection. But a cluster plan should show early how each plant answers that review. Confirm the permitting approach with TCEQ before the phasing plan is fixed.

How do you size each plant in the cluster?

From its own phase's flows, on Chapter 217's design basis. Under TCEQ's design flow rule, 30 TAC §217.32, a new plant under 1.0 MGD uses a design flow of at least 1.5 times the average annual flow from TCEQ's per capita table. Without site data, peak flow is at least 4.0 times the design flow.

Reliability is per plant too. Under TCEQ's emergency power rule, 30 TAC §217.36, each plant needs an alarm system, power outage records from its electric utility and a way to prevent untreated discharge during outages.

A cluster can share portable generators, but only with quick-connects and transfer switches at each site and a licensed operator on call around the clock. The engineering report must say which units each generator backs up.

What does each plant site need?

Its own buffer, flood protection and access. Under TCEQ's siting rule, 30 TAC §309.13, a plant unit stays out of wetlands and out of the 100-year floodplain unless it is protected from that flood.

For odor control, units sit at least 150 feet from the nearest property line, or 500 feet for lagoons with anaerobic zones. The alternatives are a TCEQ-approved odor prevention report or legal restrictions against homes in the buffer, and the chosen option must stay in place for as long as the plant is permitted.

A site picked for early construction convenience can end up ringed by homes in a later phase. Put each buffer in the land plan from the start, along with all-weather access for operators and sludge hauling.

Can each plant use a different discharge route?

Yes, and that is one of a cluster's real advantages. One plant may discharge to a stream under a TPDES permit while another irrigates under a Texas land application permit, depending on soils, land and the nearest receiving water.

Reuse sits on top of a plant's permit, not in place of it. Under TCEQ's reclaimed water notification rule, 30 TAC §210.4, a provider needs TCEQ's written approval before supplying reclaimed water to another user. Where the plant owner is also the reuse user, §210.1(c) requires the permit to provide another means of disposal for times when nobody needs the water.

What does a cluster mean for operators?

More plants means more operator coverage, not less. Under TCEQ's operator rule, 30 TAC §30.350, every plant has a chief operator licensed at or above its category. Each is operated at least five days a week by an appropriately licensed operator, with one reachable by phone seven days a week.

Small extended aeration plants of 0.10 MGD or less are Category D, unless nutrient limits or tight BOD or TSS limits move them up to Category C. Our post on package plant operator staffing walks through the levels.

Who owns each plant in the long run?

Decide at the start, because the answer changes how you site, permit and build. The developer may keep a plant, transfer it to a utility district or city, or decommission it when regional sewer arrives. A plant meant to be temporary should have its future connection route and decommissioning plan from day one.

Does a cluster fit your development?

Answer each item yes or no. Yes to items 1 to 3 means a cluster is worth studying. Any "no" on items 4 to 7 must be resolved before you commit.

  1. Do long sewer runs or separate drainage areas make one plant site impractical?
  2. Is build-out timing uncertain enough that central capacity could sit idle for years?
  3. Is regional sewer service years away, or not offered at all?
  4. Does each candidate plant site fit its buffer and stay out of the floodplain?
  5. Have you checked each site for permitted plants or sewer systems within three miles?
  6. Is there an owner, an operator and a backup operator for every plant?
  7. Have you compared lifetime operating and reporting costs, not just up-front capital?

Limits: this is general education on TCEQ rules as they read in October 2026. How TCEQ will permit a particular set of plants depends on the sites, flows and discharge routes, so confirm the approach with TCEQ early.

Frequently asked questions

Can a cluster of package plants later be consolidated into one central plant?

Yes, if you plan for it. Reserve sewer routes and a central site, and decide early how each plant's permit will end or transfer once flow moves to the central plant.

Does a cluster always cost less than one central plant?

No. It usually lowers up-front collection costs but adds operators, monitoring and permits. Compare the options over the full build-out, not just the first phase.

I'm planning a master-planned community west of Austin in four phases over ten years. Should each phase get its own package plant?

Only if the site argues for it. Check whether the phases drain to separate low points, what permitted systems lie within three miles, and whether each site can hold its buffer. Where the sewer routes allow, one permit with phased capacity at a single site is often simpler to run.

I'm an engineer for a Texas utility district reviewing a developer's plan for three small plants. What should I check first?

Each plant's operator category and coverage, its buffer and floodplain position under §309.13, its regionalization correspondence, and who will own and operate it in ten years, including the decommissioning plan for any temporary plant.
