Outfall Design and Diffuser Engineering: The Overlooked Civil Design Work Behind a Compliant Discharge Point

Outfall design decides whether a permitted discharge works in the field. See what siting, diffuser ports, scour protection and TCEQ mixing zones require.

Quick answer

Outfall design is the civil and hydraulic work that makes a permitted discharge behave in the field the way the permit assumed. The permit sets effluent limits, and the mixing zone behind those limits assumes a certain outfall. Siting, diffuser ports, the headwall, scour protection and access decide whether the real structure delivers it, so design them alongside the permit, not after it.

Why does the outfall deserve its own design attention?

Because the permit's numbers depend on it. Most planning effort goes to treatment design and permit limits, which leaves the outfall as an afterthought.

The outfall is where treated effluent actually enters the receiving water. The dilution that sits behind how TCEQ sets effluent limits assumes the outfall performs as described in the application. A poorly sited or poorly built outfall can undercut that assumption no matter how well the plant runs.

The usual symptoms are erosion nobody planned for, poor dilution, public complaints about a visible discharge, and a structure that is hard to reach for maintenance.

How do TCEQ mixing zones tie the permit to the outfall?

The mixing zone is the link between the permit's limits and the physical structure. Texas allows a reasonable mixing zone at the discharge point of a permitted discharge under 30 TAC §307.8(b), part of the standards on TCEQ's 2022 Texas Surface Water Quality Standards page. Chronic aquatic life criteria for toxic materials, and some other criteria, do not apply inside it. Acute criteria do.

Acute criteria may be exceeded only in a small zone of initial dilution (ZID), and nothing that moves through the ZID may be killed. The rule caps ZID size:

  • streams and rivers: 60 feet downstream and 20 feet upstream of the discharge point, and no more than 25% of the stream flow volume at or above seven-day, two-year low-flow conditions
  • lakes and reservoirs: a 25-foot radius, or an equivalent volume or area for a diffuser system
  • bays, tidal rivers, estuaries and the Gulf of Mexico: a 50-foot radius, or the diffuser equivalent

Mixing zones are individually specified for domestic discharges permitted at a monthly average of 1 million gallons per day or more, and for industrial discharges. Smaller domestic discharges get an assumed small mixing zone under TCEQ's implementation procedures. Where the permit defines a mixing zone, the permit's definition applies.

A version note. TCEQ's revised standards took effect September 29, 2022, but EPA has not approved all of them. For parts still under EPA review, TCEQ says TPDES permitting uses the last EPA-approved version, so check which version your permit's analysis relied on.

Where should the outfall be sited?

Where the receiving water gives the diffuser enough depth across the full range of flows. Location drives mixing behavior, erosion exposure and access for the life of the structure.

A shallow reach may not provide the depth the permit's mixing assumptions were built around. Measure actual depth and cross sections at each candidate location rather than assuming a generally suitable stretch of water will work.

How stable is the streambank at the outfall?

Check it under storm conditions, not just on the day of the site visit. An outfall that penetrates or sits next to an unstable bank can be undermined, shifted or exposed as the bank erodes or migrates.

A bank that looks stable at normal flow can behave very differently in a major storm.

What should drive pipe material and headwall design?

The conditions the pipe will actually see over its service life. Material selection has to account for exposure to the receiving water, soil loads, any traffic or equipment above the pipe, and long-term durability.

The headwall manages the transition from pipe flow to open water. It should control exit velocity and direct the flow, rather than simply ending the pipe at the water's edge.

How should diffuser ports match the permit's mixing assumptions?

Design the diffuser from the same mixing analysis the permit used. Where effluent limits assume a level of dilution, the diffuser has to deliver that dilution in the field.

The common mismatches are:

  • too few ports
  • port spacing or orientation that does not achieve adequate initial mixing
  • a diffuser sized for a different flow than the plant actually discharges

Treat the diffuser as part of the permit's technical basis, not a later civil detail.

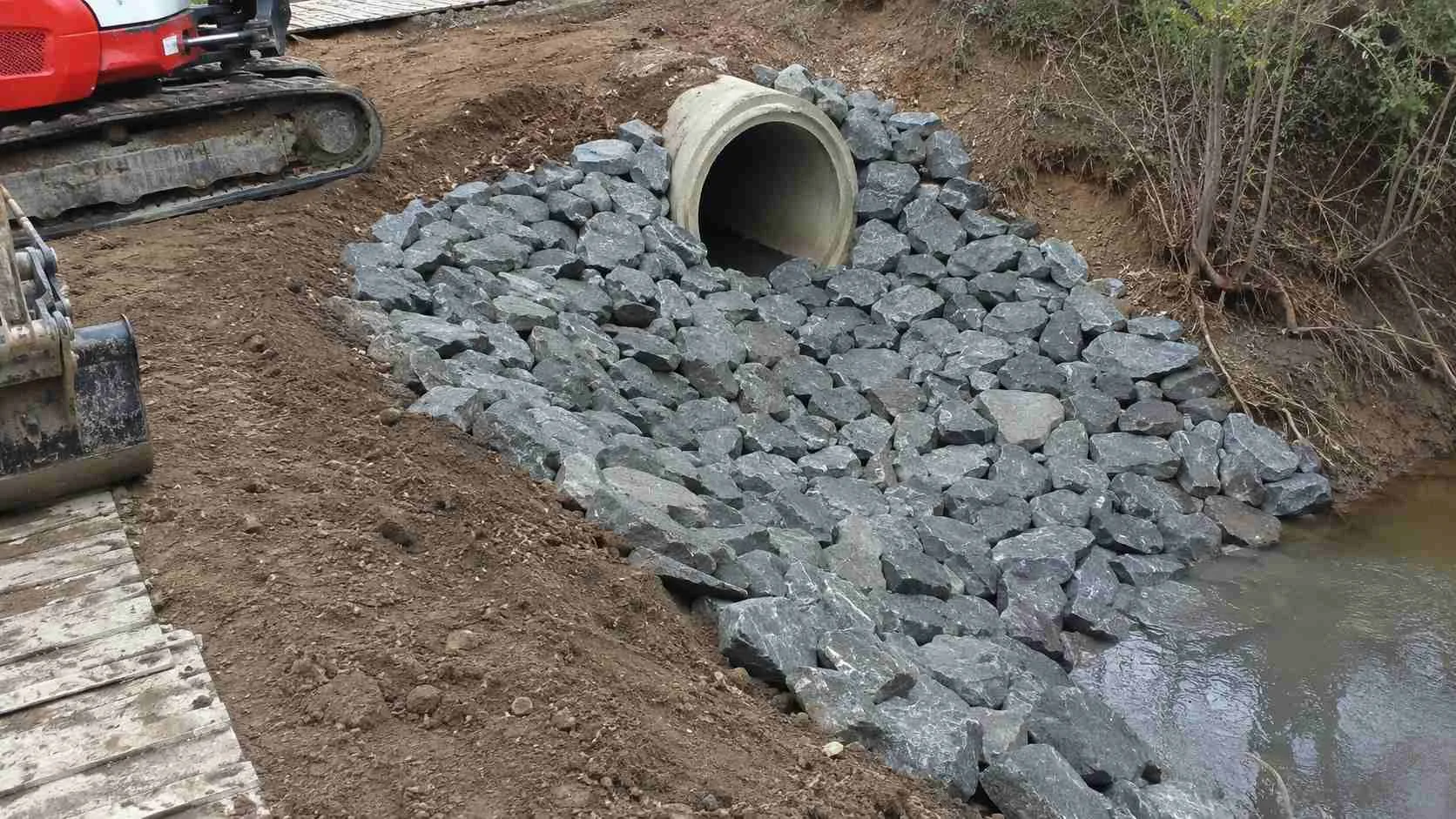

Riprap scour protection installed around an outfall

How do you size erosion protection and scour control?

From the outfall's actual exit velocity and volume, not from a generic standard detail. Concentrated flow leaving the structure creates local velocity and turbulence that wear away the bed and banks over time.

Protection sized to site-specific hydraulics prevents a slow problem that is invisible right after construction and obvious after months or years of discharge.

What other approvals can an outfall need?

Often a Corps permit and a floodplain permit, on top of the discharge permit. If the work discharges fill into waters of the United States or places structures in navigable waters, the Corps' 2026 nationwide permits in the Federal Register include NWP 7 for outfall structures whose effluent is authorized under the NPDES program (TPDES in Texas).

NWP 7 requires a pre-construction notification to the district engineer before work starts. The 2026 permits took effect March 15, 2026, and expire March 15, 2031.

If the outfall sits in a mapped floodplain, the community's floodplain administrator permits the development, as FEMA's floodplain management rules at 44 CFR 60.3 require. In an adopted regulatory floodway, encroachment is prohibited unless hydrologic and hydraulic analysis shows no increase in base flood levels. That analysis is the work of a floodplain study.

Easements matter too. Secure them for the structure and for the access corridor during design, not after construction starts and the access turns out to cross land the project does not control.

How should access, constructability and maintenance be planned?

Into the design from the start. An outfall needs periodic inspection and occasional maintenance, and access is not guaranteed just because the site was reachable during construction. A design that assumes access or methods that do not match field conditions invites change orders and delays.

Why does an afterthought outfall become a costly redesign?

Because every fix gets harder once the outfall is built. During design, moving the outfall, changing the diffuser or upsizing scour protection is a drawing change. After construction it is field remediation.

Throughout design, coordinate with the permit's specific conditions: the mixing zone definition, monitoring point locations and any outfall configuration the permit names. A quick readiness check before final design:

  1. Have depth and cross sections been measured at each candidate location?
  2. Has streambank stability been checked across a range of flows, including storms?
  3. Is the diffuser sized from the same mixing analysis and flow as the permit application?
  4. Is scour protection sized to this outfall's own exit velocity?
  5. Have Corps and floodplain approvals been identified?
  6. Are easements for the structure and its access corridor secured or in negotiation?

If any answer is no, resolve it before final design. Bring the open items to your engineer as an agenda.

Limits of this article. This is general education on outfall design in Texas. Mixing zones, ZIDs and other approvals depend on your permit, your receiving water and your Corps district, so confirm them for your site.

Frequently asked questions

Does the permit's mixing zone analysis mean the diffuser will be designed correctly?

No. The analysis sets the assumptions the permit relies on. The diffuser still has to be engineered to achieve them in the field, which means connecting the permit's technical basis to the structure being built.

How early should outfall siting be evaluated?

During feasibility and permit application planning. Depth, bank stability and access are much easier to solve by picking a better location than by engineering around a poor one.

Can an outfall erode the stream even when the discharge meets its permit limits?

Yes. Scour is a hydraulic problem, largely independent of the effluent's chemistry, so a compliant discharge can still erode an unprotected bed.

I'm developing a phased community in Texas with a package plant that will discharge to a creek. Should the first outfall be sized for buildout flow or only for phase one?

Evaluate both during initial planning. An outfall sized only for phase one may need significant modification as later phases raise the flow. The diffuser also has to perform at each phase's actual flow, so the sizing decision should follow the permit's phased flows.

I'm a civil engineer at a small firm and my client's TPDES permit is in review. Does the discharge permit cover building the outfall in the creek, or is a separate federal permit needed?

The discharge permit covers the effluent, not the construction. If the outfall work discharges fill into waters of the United States or places structures in navigable waters, it needs Corps authorization, and NWP 7 can cover it with a pre-construction notification. Confirm jurisdiction with your Corps district.
