Blog

Reactive Clay Soils and Buried Utility Design: Engineering Water and Sewer Lines on Eagle Ford and Austin Chalk Formations

Buried utility design for reactive clay in the Dallas area needs borings along the corridors, sound pipe embedment, resilient manhole connectors and testing.

Quick answer

Reactive clay soils in the Dallas area swell when wet and shrink and crack when dry, and a buried water or sewer line sits in that cycle for its whole service life. Buried utility design for reactive clay starts with borings along the utility corridors, then picks embedment, joints, manhole connections and testing for that soil. Texas sewer rules set the floor: a 50-year structural life, specified embedment, resilient manhole connectors and a 30-day deflection test.

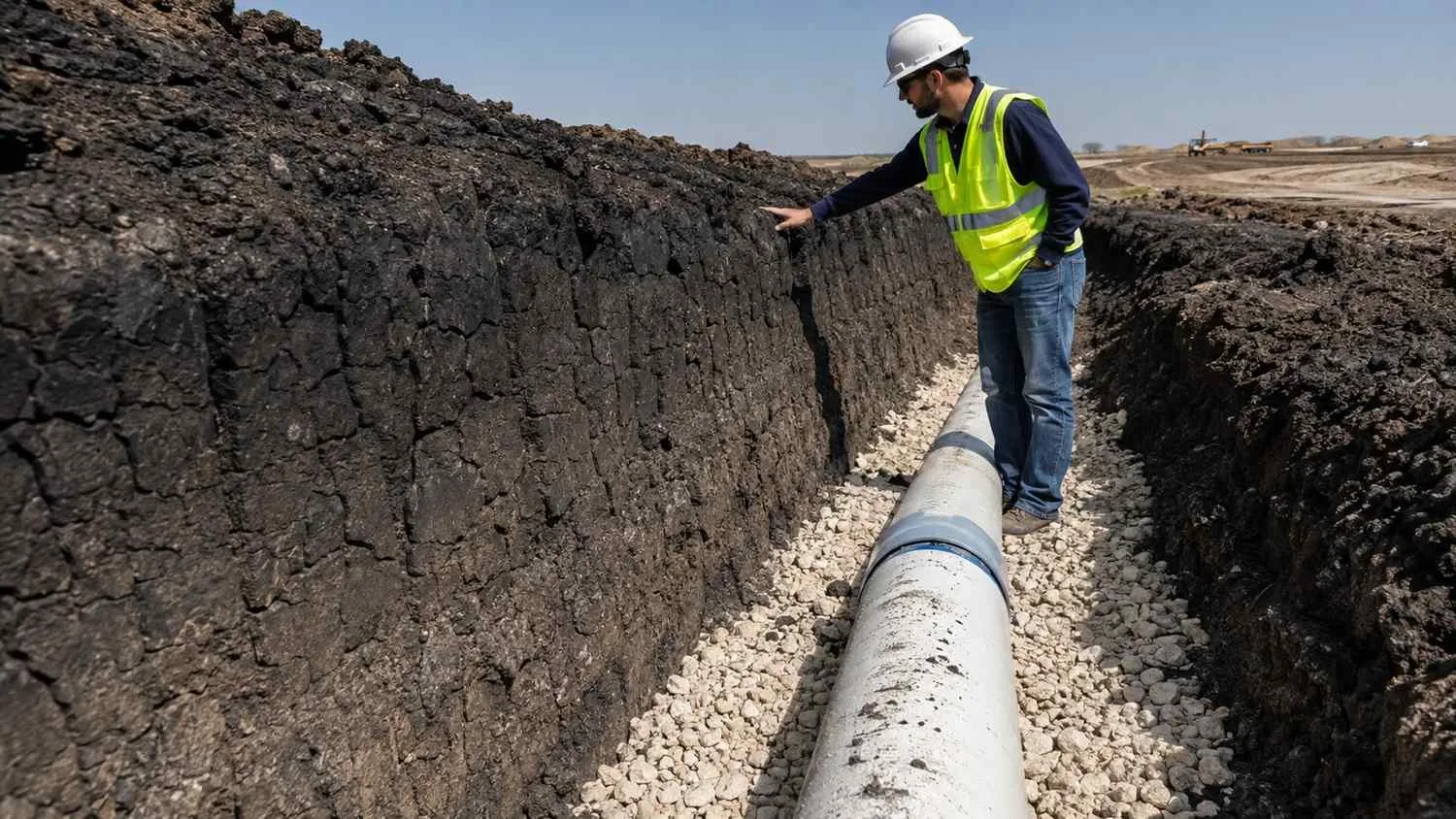

Utility trench through reactive clay soil on Dallas area Eagle Ford formation.

What is different about Eagle Ford and Austin Chalk ground?

They behave differently, so treat them differently. A geology overview given at an NCTCOG Public Works Roundup in 2022 (opens in a new tab) describes the Eagle Ford Shale as having high potential for expansive, soil-related movements and high sulfate contents. It describes the Austin Chalk as very hard limestone with seams of chalky marl and clay.

The soil surveys say the same thing from the top down. The NRCS description of Houston Black clay (opens in a new tab), a Blackland Prairie soil formed from Cretaceous calcareous mudstone, rates it high shrink-swell, with dry-season cracks up to 4 inches wide reaching 12 inches deep or more. The NRCS Austin series (opens in a new tab), formed in residuum weathered from chalk, is only moderately deep, with chalk 20 to 40 inches down.

So a sewer on an Eagle Ford or deep clay site lives in moving clay. A sewer on an Austin Chalk upland may be cut partly into chalk, with clay above it and in the seams. Each site is its own answer, and only borings along the alignment tell you which one you have.

How does shrink-swell movement damage a buried line?

It moves the pipe unevenly, and leaks make it worse. The same NCTCOG presentation lists leaks within utilities among the water sources that change clay moisture, alongside poor drainage, groundwater changes and vegetation. A leaking joint wets the clay around it, the clay swells, and the joint moves again.

What owners see over time:

  • joints pulled or offset, leaking water out or groundwater in;
  • sags in a gravity sewer that collect solids and cut capacity;
  • cracking where a rigid manhole and a moving pipe meet;
  • pavement cracks and dips that track the trench line.

Pavement distress along a trench is often the first visible sign. It is worth a camera run before the next repaving job.

What do TCEQ's sewer rules require for pipe and embedment?

A design life, a structural analysis and real embedment. Under 30 TAC §217.53 (opens in a new tab), a collection system must be designed for a minimum structural life of 50 years. For flexible pipe, the engineering report must include long-term deflection calculations and the method for determining the modulus of soil reaction for both the bedding and the in-situ soil.

There is a shortcut. Paragraph (k)(4) waives those calculations only when every listed condition holds, including pipe 12 inches or smaller, cover of 17 feet or less, no live loads, and an in-situ soil modulus of 200 psi or more. That last condition is a number your geotechnical data has to support, not an assumption.

Joints for gravity pipe must prevent inflow, infiltration and root entrance, with gasketed, compression, welded or heat-fused joints, under the same section.

The embedment rule rules out most excavated clay. 30 TAC §217.54 (opens in a new tab) requires bedding classes from ASTM C12 for rigid pipe or ASTM D2321 for flexible pipe. It prohibits debris, large clods, stones over 6 inches, organic matter and other unstable materials in the bedding, haunching or initial backfill.

The same section requires 6 inches of clearance below and beside the bell, embedment at least 12 inches over the crown, and compaction that delivers the modulus of soil reaction the design assumed.

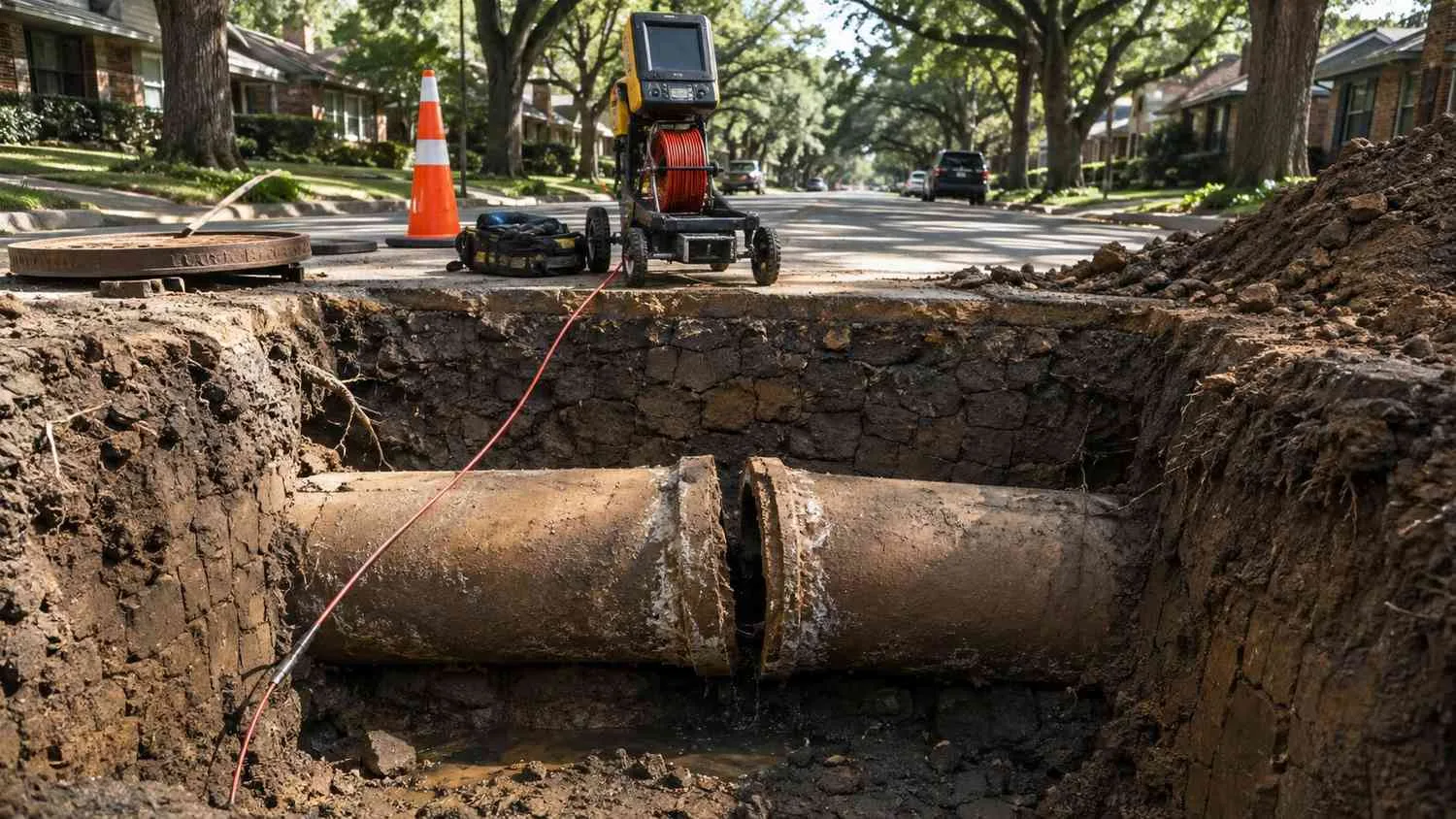

CCTV inspection revealing pipe joint deflection in Dallas reactive clay sewer main.

What do the rules say about manholes and testing?

The connection must allow for settlement, and the pipe must prove it held its shape. 30 TAC §217.55(m) (opens in a new tab) requires watertight, size-on-size resilient connectors at every manhole-pipe connection that allow for differential settlement and conform to ASTM C923. On reactive clay, that connector is doing real work.

Testing under 30 TAC §217.57 (opens in a new tab) has two parts for flexible gravity pipe:

  • a low-pressure air test or an infiltration or exfiltration test for leakage;
  • for pipe under 27 inches, a deflection test with a rigid mandrel, no sooner than 30 days after final backfill, with deflection not to exceed 5%.

A section that fails must be corrected and tested again after its final backfill has been in place at least 30 days. Television inspection does not substitute for the deflection test.

How should the trench be designed on reactive clay?

Design the trench with the geotechnical engineer, segment by segment. The rules set minimums. The site sets the rest:

  • Pipe material and joints that can tolerate the movement the soil report predicts, from flexible HDPE pipe with fused joints to gasketed PVC or ductile iron.
  • Embedment material and compaction that meet the design modulus, with a plan for keeping water from running along a granular pipe zone.
  • Backfill above the embedment that is moisture-conditioned and compacted to the geotechnical recommendation, especially under pavement.
  • Thrust restraint for water mains that does not rely on a single bearing value for soil whose strength changes with moisture.
  • Where the alignment hits chalk, excavation, bedding and any rock transition designed into the plans, not found in the field.

Depth matters too. Swell potential is evaluated over an active zone that dries and wets, and TxDOT's Tex-124-E potential vertical rise method (opens in a new tab) is one common way geotechnical reports put a number on it. Ask where your pipe sits relative to that zone.

Is your utility design ready for a reactive clay site?

Answer yes or no. Any no is a gap to close before the plans are final.

  1. Do borings and laboratory tests cover the water and sewer corridors, not only the building pads?
  2. Does the report give plasticity, swell potential and depth to chalk or rock along the alignment?
  3. Does the flexible pipe design use a measured or justified in-situ soil modulus?
  4. Are embedment class, material and compaction specified to §217.54?
  5. Do the plans call for resilient ASTM C923 connectors at every manhole?
  6. Do the specifications include the air or leakage test and the 30-day mandrel test?
  7. Is trench backfill under pavement specified with moisture and compaction requirements?

Questions for your engineer and geotechnical engineer: Which segments sit in the most active clay? Where will we hit chalk? What keeps water from tracking along the trench?

Limits: this is general education on buried utility design in Dallas-area soils. Soil behavior varies by site, and city standards add to the state rules, so confirm the design with your geotechnical engineer, the reviewing utility and your engineer of record.

Frequently asked questions

How do we know whether our site has reactive clay?

Start with the NRCS soil survey for a first look, then rely on borings and laboratory tests along the utility corridors. Plasticity index and a swell estimate such as potential vertical rise tell you how active the clay is.

Can we use the clay we dug out as pipe embedment?

Not as clods. Section 217.54 prohibits large clods and unstable material in the bedding, haunching and initial backfill, and the embedment has to deliver the soil modulus the design used. Native clay above the embedment zone is a separate decision for the geotechnical engineer.

I'm developing a subdivision near Dallas on Eagle Ford clay, and my geotechnical report only covers the house pads. What should I ask for before the utility plans are final?

Ask for borings along the main water and sewer runs, plasticity and swell data at pipe depth, depth to rock, groundwater observations and sulfate results. Then ask the geotechnical engineer for embedment, backfill and moisture recommendations written for the trenches.

We're a utility contractor, and a PVC sewer on a clay site failed the mandrel test a month after backfill. What does the rule require next?

Section 217.57 requires you to correct the problem immediately, then test again once the final backfill has been in place at least 30 days. Deflection over 5% usually points to embedment or haunching that did not give the support the design assumed.

Does Austin Chalk mean we can skip the clay precautions?

No. Chalk sites can still carry clay soils and clay seams, and a trench that runs from clay into chalk needs a planned transition. Borings tell you where each one starts.
